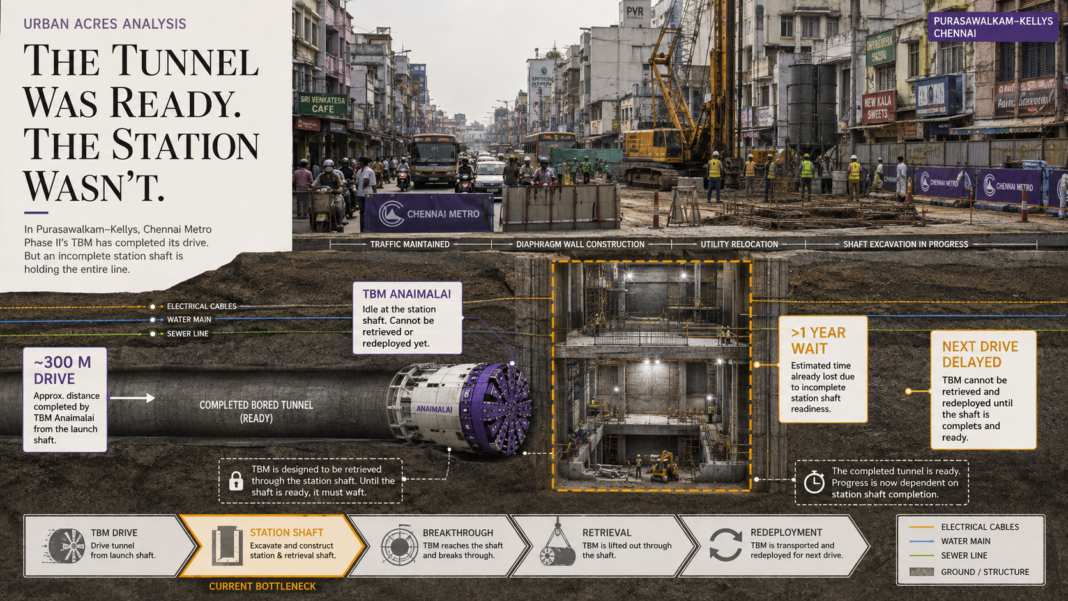

Chennai Metro has finally completed the tunnel connection between Purasawalkam and Kellys after an extraordinary delay.
The physical breakthrough is welcome.
But the strongest lesson from the Purasawalkam Kellys Metro tunnel is not about tunnel-boring technology. It is about construction sequencing.
TBM Anaimalai was recommissioned from Purasawalkam in August 2024 for its third Phase II assignment. The machine had previously completed drives between Madhavaram Milk Colony and Venugopal Nagar and between Ayanavaram and Otteri. Its Purasawalkam–Kellys assignment required a comparatively short bored drive of roughly 280–300 metres.
Yet breakthrough took dramatically longer than the tunnel length would suggest.
The machine reached Kellys before Kellys was ready
By March 2025, reporting indicated that Anaimalai had already drilled roughly 300 metres towards Kellys, but the TBM could not enter the station because construction of the receiving shaft remained incomplete.
By April 2026, it had effectively been stalled outside Kellys for more than a year. The delay was linked to shaft-construction problems and opposition from residents concerned about construction-related inconvenience.
This changes the interpretation of the milestone.
The problem was not primarily:
TBM too slow.
It was:
destination not ready when the TBM arrived.
For a major underground rail project, that is a project-management failure with consequences well beyond one machine.
TBMs are part of a production chain
Tunnel boring machines are highly specialised and expensive assets.
CMRL’s Phase II underground programme relies on repeated cycles in which machines are launched, drive between stations or shafts, are retrieved, dismantled or moved, and then recommissioned on another section.
Anaimalai illustrates the model clearly.
Its previous drives included 415 metres from Madhavaram Milk Colony to Venugopal Nagar and 925 metres between Ayanavaram and Otteri before it was recommissioned at Purasawalkam.
That means a TBM sitting idle outside an unfinished shaft is not only a problem for the tunnel it has just bored.
It delays the tunnel it is supposed to build next.
CMRL has already acknowledged a wider TBM bottleneck
In June, CMRL-linked reporting showed that this was not an isolated incident.
At least 10 tunnel boring machines had been stranded underground for months, and in some cases nearly two years, because retrieval shafts and stations were not ready when the machines reached them.
CMRL officials said delayed retrieval had:
- slowed machine redeployment;
- increased idle-time payments;
- affected subsequent tunnel drives;
- and required penalties against contractors responsible for delayed shaft readiness.
The agency was even considering acquiring additional TBMs because existing machines could not be redeployed quickly enough.
That is a substantial warning.
Buying more tunnelling machines can increase capacity.
It does not solve the underlying sequencing failure if their next station boxes are also late.
Station construction may now be the critical path
Major Metro announcements often focus on TBM breakthroughs because they are dramatic and visually understandable.
But the Purasawalkam–Kellys episode suggests that the harder delivery metric may be shaft and station readiness.
Before a TBM can safely break through into a station, the required retaining structures, diaphragm walls, excavation, support systems and receiving area must be sufficiently advanced.
In dense central Chennai, that preparation must also coexist with:
- water pipelines;
- sewers;
- power cables;
- telecom infrastructure;
- traffic diversions;
- narrow road space;
- nearby buildings;
- and public access.
Earlier work at Purasawalkam itself required substantial utility relocation. Metro-related pipeline works have temporarily disrupted water supply across several central and north Chennai neighbourhoods.
The real tunnelling schedule is therefore partly a utility-management schedule.
A delayed shaft creates a domino effect
The operational consequence is visible in Anaimalai’s planned next assignment.
CMRL officials said the Purasawalkam–Kellys machine was intended to be redeployed for the corresponding second tunnel after retrieval.
When the machine could not enter the Kellys shaft, that subsequent drive could not proceed as planned.
The dependency chain becomes:
Kellys shaft delayed
→ Anaimalai cannot break through
→ machine cannot be retrieved
→ second drive cannot begin
→ twin-tunnel completion slips
→ track and systems access slips
→ station testing slips
→ passenger opening potentially slips
This is why a delay affecting a few hundred metres can influence kilometres of future railway.
The cost of delay should be disclosed
CMRL has acknowledged paying for TBM idle time and imposing penalties where shaft-readiness delays were attributable to contractors.
The public record should now quantify that cost.
For every stranded TBM, CMRL should disclose:
| Indicator | Required disclosure |
|---|---|
| Machine | TBM name and contract package |
| Planned arrival | Original station/shaft arrival date |
| Actual arrival | Date tunnelling reached destination |
| Shaft-ready date | Date breakthrough became possible |
| Idle duration | Days machine remained unavailable |
| Cause | Utility / station contract / land / design / other |
| Idle-time cost | Amount payable |
| Contractor penalty | Amount deducted |
| Next planned drive | Section affected by delayed retrieval |
| Schedule impact | Days added to subsequent programme |
Without this information, the public cannot determine whether contractor penalties actually recover the wider project cost.
Residents bear a separate delay cost
Underground construction delays also extend disruption above ground.
Purasawalkam and adjoining central Chennai roads have endured Metro barricades, reduced road width, poor pedestrian conditions and construction-related noise and dust. A March 2026 assessment covering Metro work zones including Purasawalkam and Kellys found significant localised noise and dust impacts and reported discomfort among nearby residents.
Earlier complaints on Purasawalkam High Road similarly linked Metro construction with restricted road space and difficult movement.
That means a one-year underground delay has an above-ground social cost:
more barricades, more traffic friction, more difficult walking and longer exposure to construction activity.
Schedule management is therefore part of urban public-space management.
The Madhavaram–Kellys schedule needs an update
CMRL’s first approximately 9-km underground Corridor 3 section runs from Madhavaram Milk Colony to Kellys.
In June 2026, officials said the wider Madhavaram–Kellys underground section had been targeted for completion in October 2027 but acknowledged that revised deadlines might be necessary because of tunnelling and shaft delays.
The latest breakthrough eliminates one bottleneck.
It does not establish that the October 2027 target has been restored.
CMRL should now publish the revised critical path covering:
remaining twin tunnels → station structures → track → traction power → signalling → architectural works → testing → safety clearance → passenger opening
A tunnel breakthrough is a construction milestone.
It is not yet a service date.
Phase II still has a 2028 system deadline
The wider Chennai Metro Phase II project comprises 118.9 km, 128 stations and three corridors at an estimated completion cost of ₹63,246 crore. CMRL’s current official project-status page targets completion by the end of 2028.
Corridor 3 is particularly complex because 26.7 km of its 45.8 km alignment is underground.
The Purasawalkam–Kellys delay therefore provides an important warning for the remaining underground programme.
Future performance should not be reported only through:
metres bored or number of TBM breakthroughs.
It should include whether each machine’s destination is ready before the machine arrives.
The management metric Chennai Metro needs
CMRL should publish a rolling TBM Interface Readiness Index.
For every active machine, the dashboard would show the forecast date it reaches its destination alongside:
- receiving shaft completion;
- utility relocation;
- station excavation;
- land possession;
- traffic diversion;
- local permissions;
- and planned next deployment.
The objective should be simple:
No TBM should reach a destination that is not ready to receive it.
That sounds elementary.
The Purasawalkam–Kellys experience shows why it is not.
The public-interest test
Anaimalai finally reaching Kellys is genuine progress.
But celebrating only the cutterhead breakthrough would miss the larger lesson.
The machine appears to have performed its core tunnelling task long before the surrounding project system was ready for it.
That means Chennai Metro’s underground delivery problem is no longer purely geological.
It is organisational.
A successful Metro programme does not merely keep tunnel boring machines moving underground. It ensures stations, utilities, contracts and public-space management move fast enough that those machines never have to stop and wait for the city above them.
