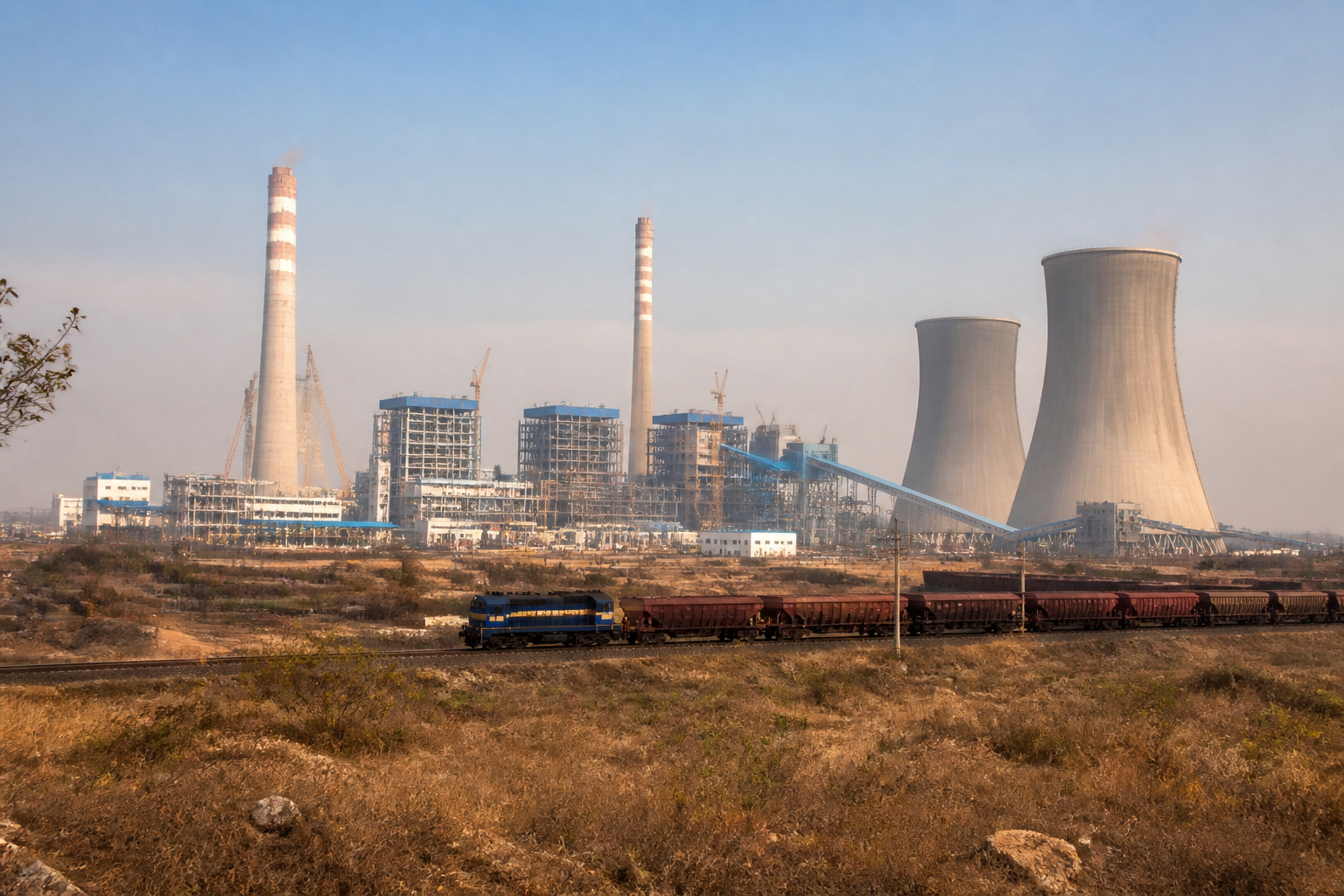

Telangana’s Yadadri Thermal Power Plant is being prepared to reach full capacity and produce 140 million units of electricity a day, but the project’s long and interrupted construction history shows that adding generation capacity is only one part of solving a state’s power-supply challenge. The plant’s progress also depends on environmental approvals, unit commissioning, coal quality, storage and the handling systems that keep a large thermal facility operating consistently.
The Yadadri project began in 2017, but work stopped after a case was filed before the National Green Tribunal. According to the report, the previous BRS government was unable to resolve the issues during its tenure. After the Congress government came to power, environmental clearance was secured in February 2024, followed by a public hearing on February 20 that year. A revised environmental clearance was obtained on May 7, 2024, and construction resumed after a 19-month interruption.
That sequence places the project within a familiar infrastructure pattern: the physical construction of a facility can move faster than the approvals and institutional decisions needed to keep it on track. A delay is not limited to the period when machinery is idle. It can also affect commissioning schedules, contractor activity, fuel planning and the point at which the investment begins contributing to the grid.
The Yadadri experience also shows how environmental governance becomes part of infrastructure delivery. The project could resume only after the clearance process was completed and the revised environmental clearance was secured. The available report does not provide the details of the National Green Tribunal case or the conditions attached to the revised clearance. It does, however, establish that regulatory clearance was a decisive milestone in restarting construction.
The plant has since moved from construction towards staged operation. Boiler light-up for Units 1 and 2 was completed on May 14, 2024. Unit 2 was connected to the power grid for the first time on September 12, 2024, while Unit 1 was connected on November 3. The first coal rake to reach the plant was flagged off on the same day. With Yadadri generating power, the remaining work is expected to be completed within six months, enabling the plant to move towards its reported full-capacity output of 140 million units a day.
These milestones matter because a thermal plant does not become a dependable source of electricity simply when its boilers are lit or when one unit is connected to the grid. The plant must also receive suitable fuel in sufficient quantities, maintain its coal-handling systems and complete the remaining works required for full operation. The steps reported by the state government indicate that fuel availability has become a central part of the plant’s readiness.
The government has increased coal storage at Yadadri and begun sending two coal trains a day from the Naini coal mines. It has also initiated steps to bring good-quality coal from Mahanadi Coalfields. The report links these measures to the need to ensure that suitable coal is available at the plant. This is a reminder that generation capacity and fuel logistics are inseparable in a coal-based power system. A large installed capacity can deliver less than expected if fuel supply, storage or handling is inadequate.
The reference to coal quality is particularly significant in the context of plant performance. The supplied report does not state the precise technical problems caused by earlier fuel constraints at Yadadri, nor does it provide an expected plant-load factor for the facility after full commissioning. What it does show is that the state has treated coal procurement and storage as operational priorities while the plant is being prepared for full capacity.
Telangana’s wider generation figures provide the backdrop to the Yadadri push. TG Generation Corporation’s thermal power capacity stood at 4,042.5 MW in December 2023 and has since reached 7,180 MW, according to the report. Its total thermal power production is currently 78.88 million units a day, compared with an average of 69.71 million units a day in 2022–23. At the beginning of 2026–27, the daily average thermal generation reached 90.23 million units.
The figures indicate a substantial increase in the state generation corporation’s thermal capacity and in reported daily output. They also show why the performance of individual projects matters beyond the boundaries of their sites. Yadadri’s full operation would add to the state’s available generation, but the final contribution will depend on whether its units can operate consistently and whether the supporting coal systems perform as planned.
The experience of the Bhadradri thermal project adds another layer to this record. Work on Bhadradri began in 2015 and was expected to be completed in three years, but it continued until 2022. Even after all four units began commercial production in 2022, problems in the coal-handling plant and the main plant affected production. After those issues were addressed, the project crossed an 80 per cent plant-load factor for the first time in 2025–26.
Bhadradri’s trajectory is important because it distinguishes between commissioning and performance. A project may reach commercial production and still fail to deliver its intended output if systems beyond the generating units remain unreliable. The reported improvement at Bhadradri suggests that resolving operational bottlenecks can be as important as adding new capacity. It also gives context to the attention now being paid to Yadadri’s coal storage, rake movement and fuel quality.
For the state’s power administration, the immediate task is therefore broader than completing the remaining construction at Yadadri. It includes coordinating environmental compliance, unit commissioning, coal procurement, railway-linked supply and plant-level handling systems. The report does not identify the agencies responsible for each stage or disclose the project’s total cost, financing structure or revised completion cost. Those details would be necessary to assess the full financial consequences of the delay.
The available evidence also does not establish whether the reported increase in thermal generation has reduced shortages, changed electricity purchases or affected tariffs for consumers. Nor does it provide a breakdown of demand from households, industry, agriculture or urban services. Those gaps limit what can be concluded about the relationship between higher generation and the lived experience of electricity users.
That limitation is important in an urban context. Reliable power supports water pumping, sewage treatment, transport systems, hospitals, commercial activity, housing construction and digital services, but the supplied report does not quantify Yadadri’s direct contribution to any of these functions. The plant’s public significance can be established through its scale and its connection to the state grid, while its precise effect on urban services will depend on future operating data.
The larger lesson from Yadadri and Bhadradri is that power planning cannot be measured only in megawatts announced or units expected. It must also be assessed through the chain that converts installed capacity into dependable daily supply: approvals, construction, commissioning, fuel quality, storage, transport, handling and plant-load performance. Delays or failures at any point can weaken the value of the investment.
Yadadri is now further along that chain than it was during the 19-month work stoppage. Its first two units have been connected to the grid, coal movement has begun and the state is preparing the plant for full-capacity operation. The next evidence to watch is whether the remaining work is completed within the expected six months and whether the plant can sustain the reported 140 million units of daily generation with reliable fuel and functioning support systems.
