HomeAnalysisTamil Nadu Vision 2035 Road Plan Needs a Public Project Ledger

Tamil Nadu Vision 2035 Road Plan Needs a Public Project Ledger

Tamil Nadu’s proposed 144-corridor road network could reshape industrial, port, airport and regional connectivity. But the ₹1.37-lakh-crore headline combines projects at different stages and may overlap with NHAI’s separately announced ₹1-lakh-crore pipeline.

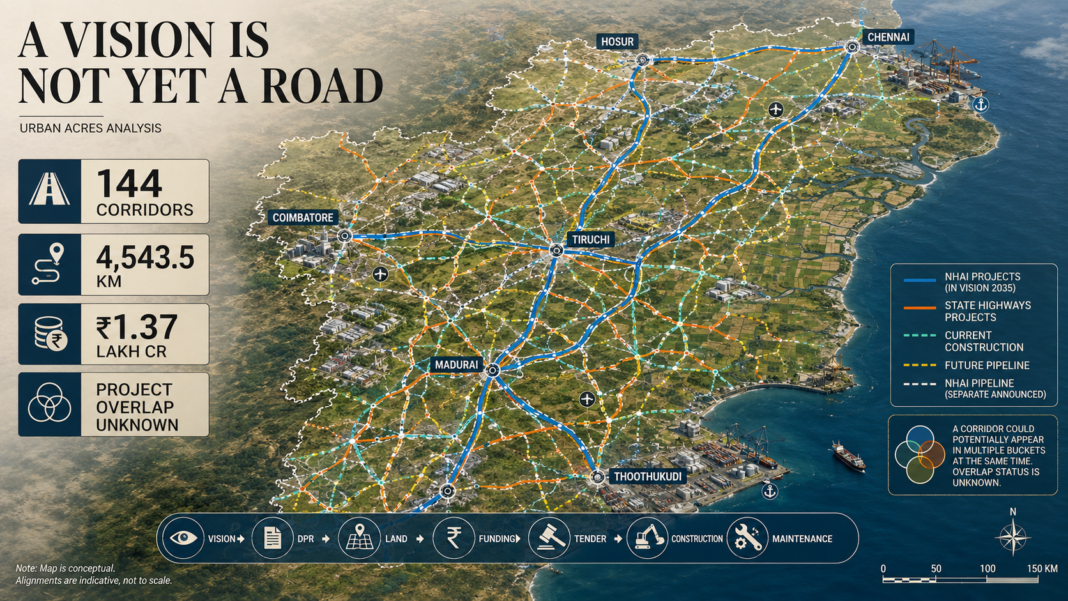

The Tamil Nadu Vision 2035 road plan proposes 4,543.5 km of road development across 144 corridors at an estimated cost of ₹1,36,996 crore. The roadmap was presented at the CII Tamil Nadu Infrastructure Summit and was described as a joint exercise involving NHAI and the State Highways Department.

The plan is organised around 20 spine corridors, 21 link roads, industrial and coastal connections, airport access, dedicated Chennai-region improvements and road master plans for Tier-II cities.

Its scale is substantial.

At the stated total, the programme carries an indicative average of approximately ₹30.15 crore per kilometre. NHAI-linked projects represent ₹84,891 crore—about 62% of the value—while State Highways projects represent ₹52,105 crore, or about 38%.

Those calculations describe the portfolio. They do not show how much money has been approved, budgeted or committed.

That distinction is the central issue.

A blueprint is not a sanctioned construction programme

The announcement contains at least five possible project stages:

  1. strategic corridor identified;
  2. master plan prepared;
  3. detailed project report underway;
  4. project approved or prepared for procurement;
  5. construction contract active.

These stages have different levels of certainty.

A line appearing in a 2035 road vision may still require traffic studies, an alignment, land acquisition, environmental approval, financing and procurement. A road already under construction has passed most of those gates.

The current reporting does not divide the 144 corridors among these categories.

The phrase “₹1.37 lakh crore road plan” should therefore be understood as an estimated capital requirement for the complete vision—not an amount already allocated for immediate expenditure.

The two NHAI numbers may overlap

The roadmap’s internal funding split assigns ₹84,891 crore to NHAI-linked projects and ₹52,105 crore to State Highways.

At the same summit, NHAI said it had another 2,500 km of national-highway projects requiring more than ₹1 lakh crore in its pipeline. It also said 855 km worth more than ₹33,000 crore was already under construction.

These numbers should not automatically be combined.

Some or all of the ₹84,891-crore NHAI component within Vision 2035 may be part of the separately described ₹1-lakh-crore pipeline. Major projects named in both discussions—such as the Chennai–Tiruchi–Madurai corridor and national-highway widening—suggest at least a reasonable possibility of overlap.

No accessible official table reconciles:

  • the Vision 2035 NHAI portfolio;
  • projects already under construction;
  • projects in NHAI’s balance-for-award list;
  • and the separate 2,500-km pipeline.

Until that table is published, describing the announcements as a combined ₹2.37-lakh-crore road programme would risk double counting.

The emerging network has a clear economic geography

The named corridors reveal a recognisable industrial and regional strategy.

The proposed Chennai–Tiruchi–Madurai access-controlled route would create a major north–south spine. Six-laning between Chengalpattu and Tindivanam would expand capacity on the established NH-32 corridor. The proposed four-laning of Nagapattinam–Thoothukudi–Kanniyakumari would strengthen eastern and southern coastal movement. Cuddalore Port links and bypasses around Coimbatore, Salem and Tiruchi would address freight and urban-through-traffic conflicts.

The strategy is not limited to intercity highways.

Nine airport-connectivity corridors are proposed, with eight assigned to State Highways and one to NHAI. Two state airport links have reportedly already entered spur-road implementation.

This creates a network with four broad functions:

  • industrial-cluster connectivity;
  • port and airport access;
  • metropolitan congestion relief;
  • regional and Tier-II city development.

The economic logic is credible. The public project-selection logic remains unpublished.

Chennai’s 13 projects require greater disclosure

The plan assigns Chennai 13 projects covering 164 km at an estimated ₹2,947 crore.

That produces an average of approximately ₹18 crore per kilometre—considerably below the indicative average for the complete Vision 2035 portfolio.

The difference may indicate that many Chennai projects involve surface-road improvements, links or lower-cost interventions rather than predominantly elevated or greenfield structures. That is an inference, not a verified project breakdown.

The public still needs to know:

  • the 13 alignments;
  • whether they are new roads, widening or junction projects;
  • their interaction with metro construction;
  • effects on bus routes and walking;
  • land and property impacts;
  • and whether each project appears in an existing Chennai mobility or master plan.

CUMTA’s involvement should allow the city to avoid evaluating these roads solely through car travel time.

A road project in Chennai should also demonstrate its effects on buses, metro access, pedestrian crossings, cycling, drainage and neighbourhood streets.

Tier-II road planning must avoid repeating metropolitan mistakes

Coimbatore, Madurai and Hosur were reported to have approved road master plans, while Thoothukudi’s was awaiting approval.

This represents an opportunity to plan growth before congestion becomes structurally embedded.

It also presents a risk.

Ring roads, bypasses and new arterials can redirect heavy vehicles away from city centres. They can also stimulate unplanned warehousing, subdivisions and ribbon development around junctions, recreating congestion at the new urban edge.

Tier-II master plans should therefore connect road investment with:

  • industrial land-use controls;
  • bus and rail terminals;
  • freight consolidation;
  • drainage and water bodies;
  • affordable housing;
  • and development controls around interchanges.

The road should implement the city plan. It should not become the uncontrolled generator of the next expansion zone.

Freight value requires multimodal performance

The programme is explicitly intended to strengthen links to industrial clusters, ports and airports.

That objective should be measured through complete freight journeys.

A new highway can reduce time between districts while trucks continue waiting at:

  • industrial-estate gates;
  • congested urban approaches;
  • port entrances;
  • customs facilities;
  • container terminals;
  • or warehouses lacking organised access.

Tamil Nadu should measure factory-to-port and factory-to-air-cargo time, not merely speed on the highway segment.

New corridors should also connect with railway freight terminals and logistics parks. Otherwise, Tamil Nadu risks expanding truck capacity while failing to shift suitable long-distance cargo to rail.

Safety must be an investment category, not a design appendix

Large road programmes frequently measure output through kilometres widened or constructed.

That can understate the value of lower-cost safety interventions.

Median closures, safe junctions, service roads, grade-separated crossings, access control, truck parking and pedestrian protection can prevent more deaths than an additional traffic lane on some corridors.

Every Vision 2035 project should therefore disclose:

  • existing fatal and serious-injury crashes;
  • expected speed changes;
  • village and school crossings;
  • local access arrangements;
  • roadside commercial activity;
  • and the post-opening safety target.

A corridor should not be considered complete until these local movements are resolved.

Climate resilience must shape corridor selection

Tamil Nadu’s road network faces intense rainfall, cyclones, flooding, heat and coastal exposure.

A Vision 2035 programme cannot rely solely on historical rainfall assumptions.

Each project should publish:

  • flood levels;
  • drainage catchments;
  • culvert capacity;
  • water-body crossings;
  • coastal erosion or salinity exposure;
  • heat-resilient pavement specifications;
  • and emergency diversion routes.

Road embankments can obstruct natural drainage when cross-flow structures are inadequate. Greenfield corridors can also alter runoff and intensify flooding in adjacent settlements.

Climate analysis must therefore influence alignment and structural design before land acquisition—not appear later as mitigation.

Maintenance liabilities should be published with capital costs

At ₹1,36,996 crore, the capital requirement is the most visible figure.

The less visible obligation begins after construction.

Road surfaces require periodic renewal. Bridges require inspection and bearing replacement. Drains need desilting. Intelligent transport systems, lighting and safety equipment require continuous maintenance.

Every corridor should have a lifecycle-cost estimate and a named maintenance funding source.

Without this, the state may create a larger network while spreading available maintenance budgets across more assets, reducing overall road quality.

The programme needs one public ledger

Tamil Nadu and NHAI should publish a common digital register covering all 144 corridors.

Each project should include:

FieldAccountability purpose
Corridor name and chainagePrevents duplicate descriptions
Implementing authoritySeparates state and NHAI responsibility
Vision categorySpine, link, airport, port, industrial or urban
Project stageConcept, DPR, approval, tender, award or construction
Estimated and awarded costDistinguishes planning estimate from contract value
Funding modelBudget, EPC, HAM, BOT or external finance
Land required and possessedShows construction readiness
Environmental statusIdentifies approval and ecological risk
Toll statusClarifies future user charges
Freight and passenger benefitStates the measurable purpose
Safety baseline and targetMakes casualty reduction auditable
Start and completion datesEstablishes delivery accountability
Overlap identifierPrevents NHAI projects being counted twice

The overlap identifier is particularly important.

A corridor included in Vision 2035, NHAI’s pipeline and a balance-for-award list should appear once, with three status labels—not as three separate investments.

The right question is not whether ₹1.37 lakh crore is large enough

The programme’s economic ambition is clear. Tamil Nadu’s manufacturing and export geography requires strong road links among cities, factories, ports and airports.

But investment scale is not a substitute for project quality.

The blueprint should be judged through five tests:

  1. Readiness: Can the project begin without unresolved land and approvals?
  2. Network value: Does it complete a missing connection rather than duplicate existing capacity?
  3. Multimodal value: Does it improve access to rail, bus, port and airport systems?
  4. Safety and climate value: Does it reduce deaths and withstand future hazards?
  5. Financial sustainability: Are construction and long-term maintenance affordable?

The available evidence establishes a 4,543.5-km strategic vision.

It does not yet establish that ₹1.37 lakh crore is funded, that all 144 corridors are approved, or that the separate NHAI pipeline represents additional non-overlapping investment.

Tamil Nadu’s next infrastructure announcement should therefore be the corridor ledger.

That document would reveal whether Vision 2035 is an integrated road-delivery programme—or a valuable but still unranked inventory of future possibilities.
