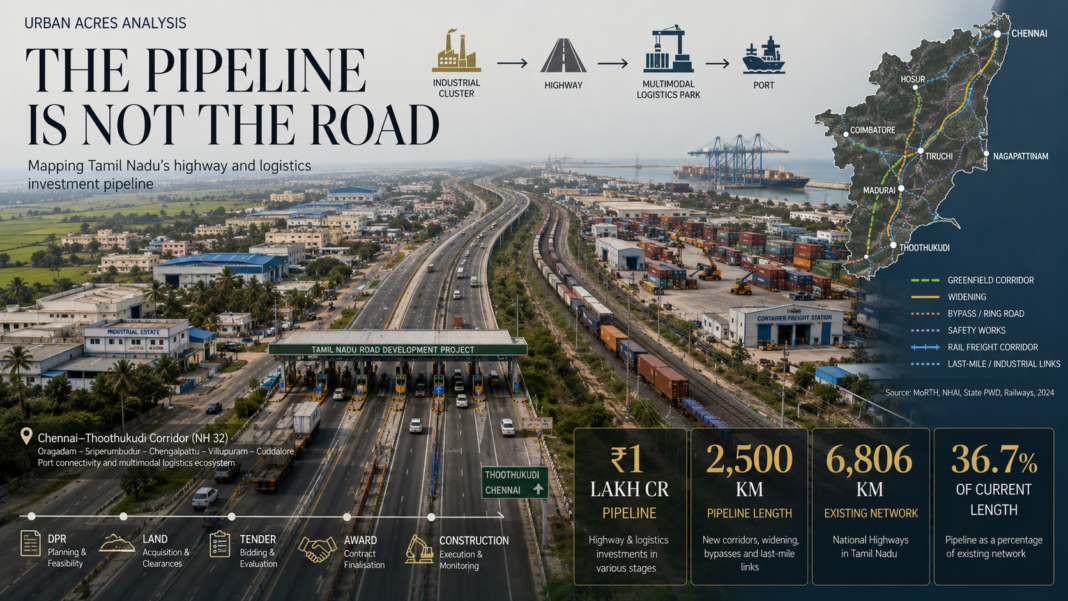

Standfirst: Tamil Nadu highway projects covering approximately 2,500 km could reshape port and industrial connectivity, but the ₹1-lakh-crore pipeline combines proposals at very different stages of readiness.
The Tamil Nadu highway projects pipeline is being presented at a scale usually associated with a new generation of regional infrastructure. NHAI reportedly has more than ₹1 lakh crore of projects covering approximately 2,500 km under consideration across the state, with the stated objective of improving freight movement and access to industrial clusters and ports.
Official NHAI communications broadly support the direction of the announcement. Tamil Nadu’s National Highway system now extends for approximately 6,806 km, more than 75% of which NHAI says has been upgraded. The authority also identifies another ₹1 lakh crore of investment in the pipeline and highlights projects such as the Chennai–Bengaluru Expressway and Chennai Port–Maduravoyal corridor.
The 2,500-km figure is therefore substantial. It is equivalent to approximately 36.7% of the entire existing National Highway network in the state. Dividing the reported investment by the reported length produces an indicative average of ₹40 crore per kilometre.
That average should not be used to judge individual schemes.
One kilometre of conventional highway widening cannot be compared directly with one kilometre of elevated road, urban interchange, bridge-heavy greenfield expressway or ghat realignment. Land cost, structures, service roads, utility relocation, pavement design and safety infrastructure can create very different project costs.
The more important qualification is that ₹1 lakh crore in the pipeline is not ₹1 lakh crore under construction.
NHAI’s March 2026 balance-for-award document confirms a wide range of Tamil Nadu projects, but they appear at different levels of maturity. Some have detailed lengths and procurement modes. Others remain under DPR preparation or have funding and delivery mode listed as “to be determined.”
The distinction becomes clearer when the Tamil Nadu figure is compared with NHAI’s national award programme. For FY2026–27, NHAI reportedly identified 54 projects across India covering 2,442 km and costing ₹1.8 lakh crore. The Tamil Nadu pipeline alone is described as approximately 2,500 km. The reasonable inference is that the state figure is a multi-year portfolio encompassing studies, future tenders and works beyond the current annual award plan—not a set of projects all due for immediate contract.
This does not weaken the significance of the programme. It changes the accountability question.
Instead of asking only how many kilometres NHAI plans, Tamil Nadu needs a stage-wise public inventory showing which projects have:
- completed DPRs;
- approved alignments;
- environmental and forest clearances;
- available right of way;
- confirmed funding;
- invited bids;
- awarded contracts;
- appointed dates;
- and measurable completion targets.
Without that information, the headline compresses planning intention and construction commitment into one number.
The emerging map is economically coherent
The accessible project documents nevertheless reveal a recognisable geographic strategy.
South of Chennai, NHAI lists a 93-km Tambaram–Chengalpattu–Tindivanam capacity-augmentation proposal and a separate 68.65-km six-laning scheme between Paranur and Tindivanam. These corridors would influence one of Tamil Nadu’s most important manufacturing, residential, port and intercity axes.
In western Tamil Nadu, a proposed approximately 99.5-km Coimbatore–Sulur–Karur corridor would strengthen movement between the Coimbatore industrial region, Tiruppur’s manufacturing economy and central Tamil Nadu.
Around Tiruchi, the list includes approximately 45.9 km of access-controlled bypasses, including an elevated section at Panjappur. Southern proposals include four-laning between Rajapalayam and Shenkottai and a 133.793-km Dindigul–Theni–Kumili corridor under DPR preparation.
In the Cauvery delta and eastern districts, the pipeline includes the Thiruvarur bypass and four-laning of substantial portions of the Nagapattinam–Thanjavur route. A greenfield bypass near Gangaikonda Cholapuram was also advanced in March 2026.
This distribution suggests a programme built around four broad functions:
- expanding Chennai-region capacity;
- connecting western manufacturing centres;
- strengthening central and southern interstate routes;
- and improving access to ports, pilgrimage centres and delta markets.
That direction is consistent with Tamil Nadu’s Logistics Policy, which identifies transport corridors through the geography of industrial and trade clusters and emphasises the state’s port system and intermodal links.
The pipeline is more than greenfield expressways
Public discussion of highway investment often focuses on new six- or eight-lane corridors. NHAI’s own project list shows a more varied programme.
It includes bypasses, widening, service roads, vehicle underpasses, elevated sections and permanent rectification of accident blackspots. Specific works are listed for dangerous locations on NH-32, NH-38, NH-79 and other routes.
This component may produce higher public value per rupee than some prestigious greenfield projects.
A grade-separated junction, safer median, properly designed service road or vehicle underpass can reduce fatalities and local conflict on an existing corridor without acquiring an entirely new alignment. Conversely, adding lanes without correcting access points, bus stops, pedestrian movement and roadside development can increase speed while preserving the conditions that produce severe crashes.
The programme should therefore separate kilometres into categories:
- new greenfield access-controlled highways;
- widening of existing roads;
- bypasses and ring roads;
- port and logistics links;
- bridges and elevated corridors;
- safety rectification;
- and maintenance or rehabilitation.
Only then can the public understand what the 2,500-km figure contains.
Port connectivity is the strongest economic case
Tamil Nadu’s industrial model is highly dependent on manufactured exports. Automobiles, auto components, electronics, textiles, engineering goods, footwear and energy equipment must move between factories, warehouses, ports and airports with predictable timing.
Road investment can reduce this friction when it removes a clear bottleneck between an industrial cluster and a freight gateway.
The Chennai Port–Maduravoyal elevated corridor is an example of this logic: its principal purpose is to separate port-bound freight from congested urban roads. The Chennai–Bengaluru Expressway similarly links industrial territories across Tamil Nadu, Andhra Pradesh and Karnataka. Official NHAI communications identify both among the state’s major transformation projects.
The coastal programme also includes the 46-km Marakkanam–Puducherry section, for which bids worth approximately ₹2,200 crore had been invited.
But a highway does not independently create an efficient port system.
A container’s complete journey includes factory access, warehouse handling, city-edge congestion, port gates, customs, terminal processing and vessel schedules. Time saved on an intercity highway can be lost in the final five kilometres outside a port.
Tamil Nadu should therefore judge each port-connectivity road through door-to-gate freight time rather than highway speed alone.
Road construction cannot replace multimodal logistics
The largest strategic risk is that a successful highway programme increases Tamil Nadu’s dependence on trucks without creating enough rail and intermodal capacity.
The state’s logistics policy recognises intermodal connections, while the World Bank identifies rail-linked multimodal logistics parks and strong last-mile access as critical to efficient freight systems.
Road freight is essential for short distances, time-sensitive cargo and factory-to-terminal movement. Rail becomes more efficient for many long-distance and high-volume flows. Ports require both.
A highway-led industrial corridor should therefore be planned with:
- railway freight terminals;
- logistics parks;
- truck holding areas;
- warehousing zones;
- port gate systems;
- and local industrial access roads.
Without these components, new road capacity can encourage warehouse and industrial development at interchanges while concentrating additional truck traffic around towns and port approaches.
Tamil Nadu already has a parallel state-highway programme. ADB’s Tamil Nadu Industrial Connectivity Project is upgrading and maintaining around 590 km across 16 roads, with explicit provisions for road safety, institutional capacity and performance-based maintenance.
This is significant because a high-speed National Highway is only as effective as the state and district roads connecting factories and towns to it.
Land readiness will determine the real schedule
The principal obstacle to many highway projects is not engineering. It is land.
A road may have an approved concept and DPR but remain years away from construction if the alignment crosses fragmented holdings, buildings, industrial premises, water bodies or contested land.
MoRTH’s contracting guidance emphasises substantial right-of-way availability before contract execution because awarding works without land exposes contractors and the public authority to delay, claims and cost escalation.
For each major Tamil Nadu project, NHAI should disclose:
- total land required;
- land notified;
- compensation awarded;
- possession completed;
- structures affected;
- forest or wetland area;
- and unresolved litigation.
This information is especially important for greenfield roads, whose economic benefits may be accompanied by farmland conversion, severed village access and speculative real-estate development around interchanges.
The project design should include local crossings, service roads, cattle and agricultural movement, school access and drainage from the beginning—not as later mitigation.
Financing will shape who pays
The project list includes several delivery models.
Under EPC, government finances construction and pays a contractor to build the road. Under HAM, the government provides approximately 40% during construction while the private concessionaire finances the balance and receives annuity payments after completion. BOT-Toll transfers greater traffic and revenue risk to the concessionaire, which recovers investment through tolls.
These models affect the long-term public cost.
A project may reduce the immediate budget requirement while creating annuity commitments over many years. A tolled project may attract private investment but transfer more direct cost to road users. Commercial freight operators can accept tolls when time, fuel and reliability savings exceed the fee; local users may receive less benefit if short journeys become tolled or access is restricted.
NHAI should therefore publish the proposed delivery and toll model before land acquisition is substantially advanced.
The ₹1-lakh-crore figure must also be separated into:
- government capital expenditure;
- private construction finance;
- future annuity liabilities;
- toll-financed investment;
- and land cost.
Otherwise, “investment” can be mistaken for immediate public spending.
The programme needs a readiness and value score
Tamil Nadu should not prioritise projects merely because they are long or politically visible.
Each project should receive a public score across five tests:
Freight value: Does it remove a measurable bottleneck between production and a port, airport, rail terminal or market?
Construction readiness: Are land, clearances, utilities, financing and design substantially complete?
Safety value: Does it correct high-fatality locations and provide safe local access?
Multimodal value: Does it connect with rail, public transport, logistics parks and port systems?
Environmental and settlement risk: How much new land, drainage alteration and community severance does it create?
Projects with high freight and safety benefits and low delivery risk should move first. Projects with uncertain demand, unresolved land or weak multimodal links should remain at the study stage until their case is stronger.
The evidence supports NHAI’s broad proposition that Tamil Nadu requires another major generation of highway investment. The state’s manufacturing geography, port network and dispersed industrial clusters create a legitimate need for faster and more reliable freight movement.
What the evidence does not yet show is whether all 2,500 km have approved funding, available land and credible award schedules—or how the ₹1 lakh crore is divided among construction, land, private finance and future public liabilities.
The next public document should therefore not be another aggregate investment announcement.
It should be a project-by-project pipeline ledger showing stage, cost, land, funding model, safety case, freight benefit and expected completion.
That ledger would reveal whether Tamil Nadu has ₹1 lakh crore of construction-ready infrastructure—or ₹1 lakh crore of projects still competing to become real.
