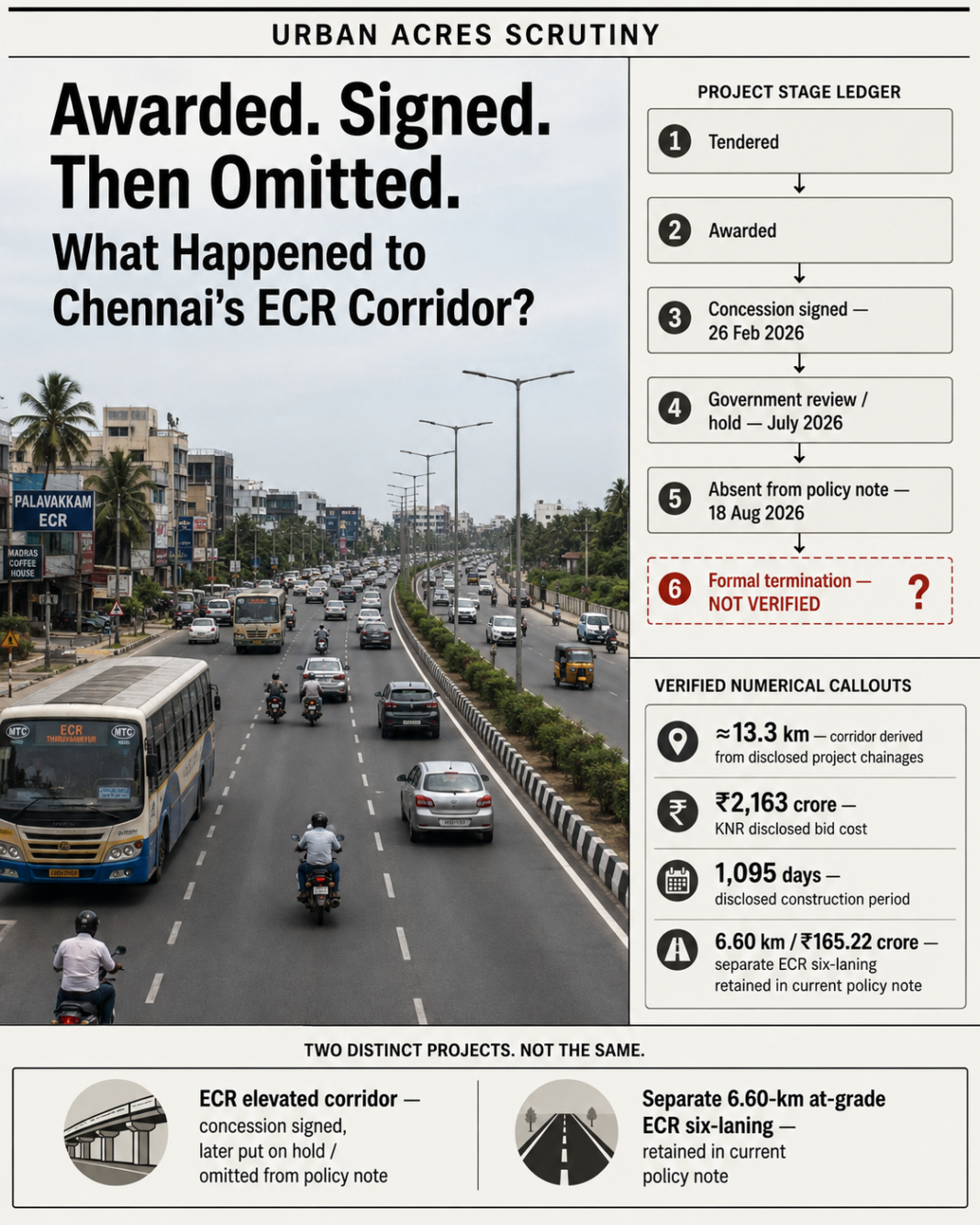

Tamil Nadu has removed one of Chennai’s most consequential recent road concessions from the visible pipeline of ongoing Highways projects, but the documentary trail does not yet support describing the ₹2,000-crore-plus East Coast Road elevated corridor as formally terminated.
The Highways and Minor Ports Department’s 2026–27 policy note, published on 18 August, identifies continuing elevated-corridor and grade-separator works including the ₹621-crore Teynampet–Saidapet corridor and other Chennai projects. The proposed four-lane ECR elevated corridor between Thiruvanmiyur and Uthandi does not appear in that spill-over list.
That omission matters because this was not an early-stage DPR waiting for approval.
Tamil Nadu State Highways Authority had already run a formal concession procurement under tender reference 02/TANSHA/ECR-EC/2025. KNR Constructions subsequently informed the stock exchanges that a specially incorporated subsidiary, KNR Mahabalipuram Infra Private Limited, signed the Hybrid Annuity Mode concession agreement with TANSHA on 26 February 2026.
KNR later described the project as carrying a ₹2,163-crore bid cost, with a 1,095-day construction period and five years of operation from commercial operation date. Those numbers describe the contracted project structure; they should not be read as State expenditure already incurred.
The distinction becomes important because changing course after a concession agreement has been executed is institutionally different from abandoning a study.
From award to review
Questions about the ECR procurement pre-date the current policy-note omission. A competing bidder, Dilip Buildcon, challenged the tender evaluation in the Madras High Court.
But the court record complicates a frequently repeated narrative that the State simply ignored a substantially cheaper qualifying bidder. The evaluation placed Dilip Buildcon, M. Venkata Rao Infra Projects and Bekem Infra Projects in the non-responsive category because they were found not to meet stipulated technical and financial-capacity requirements. KNR, NCC and Navayuga were classified as responsive.
That does not settle the broader value-for-money question. Governments are entitled—and obligated—to examine whether estimates, scope, tender conditions, risk allocation and prices are reasonable. The new policy note itself promises stronger procurement transparency and says infrastructure prioritisation should rest on traffic demand, technical soundness and economic viability.
But any review of this particular contract should compare equivalent scopes and responsive bids rather than relying on headline differences alone.
By July, the new government had decided to keep the corridor on hold pending examination by a technical committee. The latest reporting says a temporary stop notice has been issued and that committee members have yet to be appointed.
That makes the present status suspension and review, with strong evidence that the administration no longer intends to proceed on the original trajectory—but without a verified final termination instrument.
The contractual question now matters as much as the engineering question
Stopping an awarded HAM concession can have consequences that do not exist when a government drops an unawarded scheme.
Those consequences depend on the signed concession agreement: whether an appointed date was issued, how much mobilisation occurred, whether financing was drawn, what termination provisions apply, whether either side committed a default, what compensation formulas govern termination and whether work already undertaken is payable.
The current newspaper report says officials are concerned about possible arbitration and that the contractor has mobilised equipment and financing. Urban Acres has not found primary documentation quantifying those liabilities. They must therefore remain reported claims rather than booked public costs.
Before taxpayers can judge whether cancelling or restructuring the project saves public money, the government needs to disclose not merely the original tender estimate but the net fiscal consequence of the alternative decision.
A sea-link cannot yet be counted as its replacement
An additional complication is the government’s new proposal for a much longer coastal connection running from Ennore through Mamallapuram towards Puducherry, alongside an examination of passenger boating.
That proposal may ultimately alter the State’s approach to coastal mobility. It cannot yet be treated as a direct substitute for the ECR elevated corridor.
Tamil Nadu’s own policy framework says coastal projects emerging from the Maritime and Waterways Master Plan would move forward only after detailed feasibility, statutory approvals, funding availability and government approval.
The ECR road concession had already crossed procurement and contract-signing stages. The sea-link has not.
Comparing the two as though they are interchangeable delivered assets would collapse completely different project stages.
What is still happening on ECR
The elevated road is also not the only infrastructure intervention along this corridor.
The 2026–27 policy note specifically retains widening and strengthening of 6.60 km of East Coast Road through Neelankarai, Injambakkam and Sholinganallur to six lanes, with a stated cost of ₹165.22 crore.
That project should be reported separately from the elevated corridor.
At-grade widening may add road capacity, but it does not automatically reproduce the travel-time, junction-bypass or through-traffic function for which an elevated corridor would have been designed. Conversely, an elevated road would itself require scrutiny over traffic induction, access, tolling, local street impacts and how much benefit accrues to buses and other users.
The proper policy comparison is therefore not “flyover versus no flyover.”
It is which combination of road, junction, bus, public-transport, traffic-management and coastal infrastructure produces the strongest mobility outcome per rupee and with the lowest contractual and urban cost.
The next document matters more than the policy-note omission
Tamil Nadu’s current policy note says TANSHA projects are to be assessed for strategic importance, traffic potential, technical feasibility, financial viability, affordability, risk allocation and value for public resources.
The ECR decision is an immediate test of that standard.
If the corridor is being terminated, the government should disclose the expert review, the contractual mechanism used to terminate it and the resulting public liability.
If it is being redesigned, the revised scope and value-for-money comparison should be published.
If it remains only temporarily suspended, the government should say what evidence will decide its future and by when.
The public-interest question is no longer whether an elevated road was announced. It is whether Tamil Nadu can transparently show that stopping, modifying or retaining an already-signed infrastructure concession produces the better mobility and financial outcome for Chennai.
