HomeAnalysisChennai Metro Phase II Is 54.62% Physically Complete. But How Much Is...

Chennai Metro Phase II Is 54.62% Physically Complete. But How Much Is Actually Passenger-Ready?

About 67 km of ballastless track has now been laid across Chennai Metro Phase II, according to a fresh CMRL status update reported by Times of India. But the more consequential number for Chennai is still missing: how much of the ₹63,246-crore network has completed the full journey from construction to reliable passenger operation?

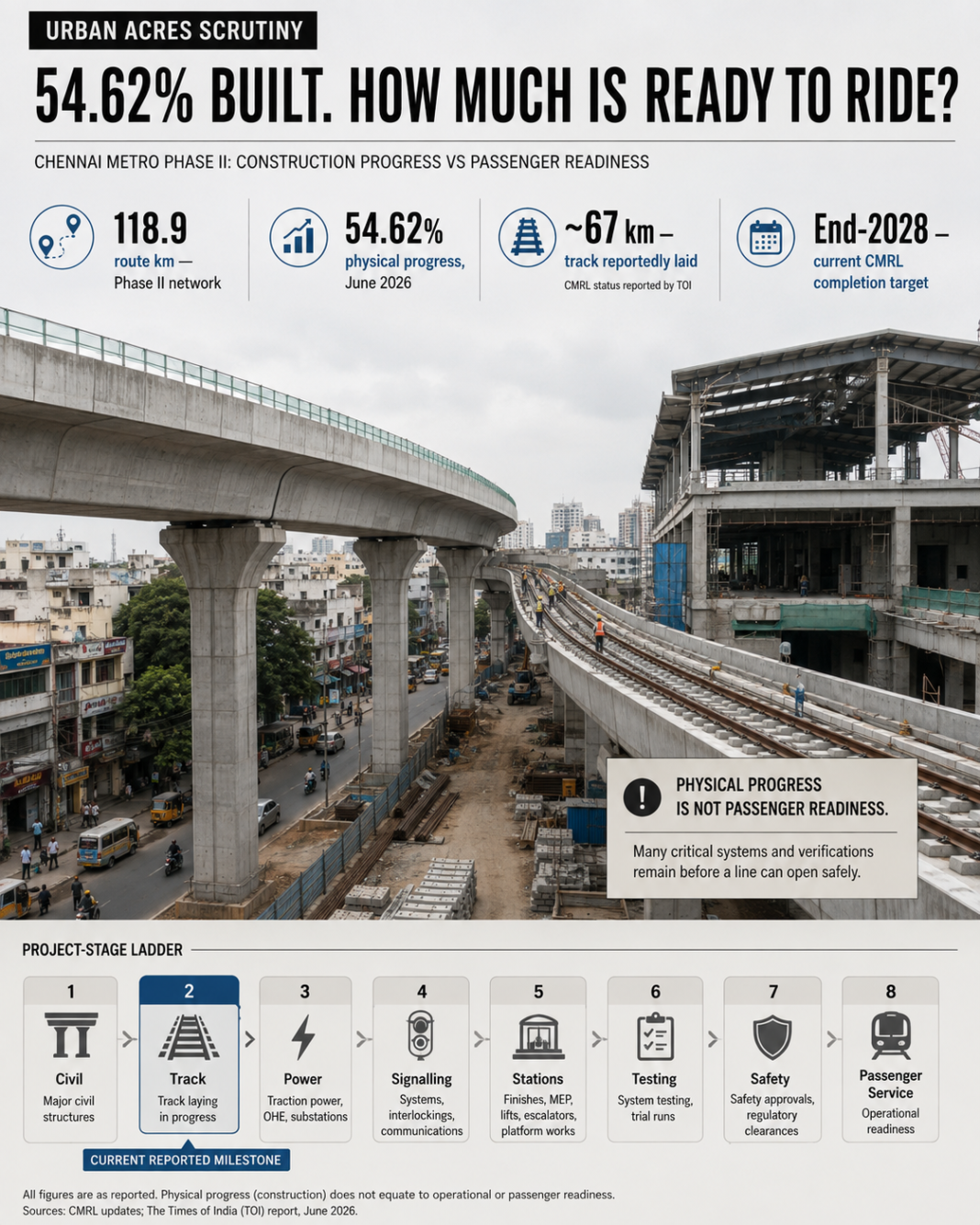

Chennai Metro Rail’s 118.9-km Phase II expansion has crossed the halfway point in aggregate construction, but that number requires a more precise interpretation than its headline suggests.

The Ministry of Housing and Urban Affairs recorded 54.62% physical progress as of June 2026 in parliamentary disclosures published in July. The figure covers the complete Phase II programme of three corridors and 128 stations. It is an official construction-progress measurement — not a statement that 54.62% of the new Metro network is available to commuters.

A fresh Times of India report adds another progress marker. Citing a CMRL official, it says approximately 67 km of ballastless track has been laid: about 32 km on Corridor 4 between Poonamallee Bypass and Kodambakkam, 24 km on Corridor 5 between Chennai Trade Centre and Koyambedu and 10.5 km on Corridor 3 between Nehru Nagar and Karapakkam.

That figure is useful — but it should not be confused with the project’s 118.9-km route length.

CMRL itself uses 118.9 route km when describing the Phase II network in its operation-and-maintenance documentation. The authority separately identifies Corridor 4, for example, as 16 km elevated and 10.1 km underground.

That strongly suggests the 67-km figure is counting installed track rather than unique route length. A twin-track Metro can accumulate substantially more track-kilometres than route-kilometres. Until CMRL publishes the precise denominator, dividing 67 by 118.9 would therefore create a misleading “percentage of network track completed”.

Construction progress is not operational progress

The distinction matters because a Metro corridor becomes useful only after several systems converge.

A viaduct without track cannot carry a train. Track without traction power and signalling cannot support commercial operations. A technically complete railway without ready stations, fire-life-safety systems, passenger access, rolling stock integration, testing and statutory authorisation still cannot provide a public service.

Phase II’s 54.62% therefore captures construction output; it does not answer the question commuters care most about: when can they board?

The clearest example is the western section of Corridor 4.

TOI reports that the approximately 14.64-km Poonamallee Bypass–Vadapalani stretch has completed mandatory safety requirements but remains awaiting passenger opening. Earlier safety inspections and conditional commissioning requirements demonstrate precisely why the end of civil or track work cannot automatically be equated with commercial operation.

The project deadline has also changed

When the Union Cabinet formally approved the full Phase II project in October 2024, it put the completion cost at ₹63,246 crore and said the 118.9-km network was planned for completion in 2027.

CMRL’s current project-status material now says the project is proposed to be completed by the end of 2028.

That one-year-plus movement in the programme-level target is a firmer basis for examining delay than simply characterising construction as slow.

TOI attributes the revised timelines to explanations from CMRL officials including the pandemic, underground-utility relocation, retendering of some station works and labour availability. Those explanations may be legitimate; different construction packages also face very different engineering conditions.

Underground works cannot reasonably be benchmarked against repetitive elevated viaduct construction on a metre-for-metre basis. Land availability, station boxes, tunnelling interfaces, utilities, traffic management and systems integration all affect package sequencing.

There is also evidence of substantial recent progress. CMRL announced in July that piling and U-girder casting had been completed across the elevated OMR stretch of Corridor 3, while underground TBM work continued into August.

The issue, therefore, is not whether work is happening. It is whether the remaining work is being translated into predictable staged openings.

Track itself remains a live procurement and delivery interface

CMRL’s awarded-contract records show separate ballastless-track packages across Corridors 3, 4 and 5, including a ₹337.76-crore Corridor 4 track contract originally awarded to IRCON and separate packages for Corridors 3 and 5.

A 2026 central e-procurement record also shows IRCON procuring balance track works under the Corridor 4 package between Lighthouse and Poonamallee Bypass. This establishes that portions of the track package remained under execution this year; it does not by itself establish why they remained unfinished.

That distinction is important for accountability. A re-procurement event may indicate changed scope, subcontracting, residual works or delivery problems. Liability should not be inferred without contract records showing the cause.

₹63,246 crore also needs financial discipline

The ₹63,246-crore number is the approved project completion cost, not cumulative expenditure.

Phase II uses a layered financing model. CMRL says financing for 52.01 km of Corridors 3 and 5 was tied up with JICA, while the remaining 66.89 km was posed to multilateral institutions including ADB, AIIB and the New Development Bank. AIIB separately records a sovereign financing commitment for Corridor 4 alongside ADB and NDB co-financing.

The financial accountability question should therefore be expressed through physical progress versus financial progress by contract package, not simply the sanctioned headline cost.

Operations have already been contracted — but that is another financial category

CMRL issued Delhi Metro Rail Corporation a Letter of Acceptance in April 2025 to operate and maintain the complete 118.9 route-km Phase II system and its three depots.

The disclosed gross O&M contract cost is ₹5,870 crore, covering a 12-year term beginning from the commercial-operation date of the final Phase II stage, with a possible three-year extension subject to performance.

That ₹5,870 crore is an O&M commitment and should not simply be added to the ₹63,246-crore capital completion cost as though the two represented the same financial scope.

It does, however, make one aspect of lifecycle planning unusually visible: the future operator has already been identified well before completion of the full civil network.

What Chennai should be shown next

CMRL’s public project-status page currently provides the project’s network configuration, broad financing arrangements, sanctioned cost and completion target. What it does not provide in one transparent dashboard is the metric needed to interpret the 54.62% figure from a commuter perspective.

For each operational stage, CMRL should publish:

route length → civil completion → track completion → traction power → signalling → station systems → rolling stock availability → integrated testing → CMRS status → scheduled commercial opening.

That would prevent kilometre figures from becoming proxies for outcomes they do not measure.

Chennai residents have already borne the road-space occupation, diversions, narrowed carriageways and construction disruption associated with one of India’s largest urban rail expansions. The measure of delivery is therefore no longer simply how many piles, girders, tunnels or kilometres of rail have been completed.

It is how rapidly those individual assets can now be assembled into continuous, safe, accessible and reliably operated passenger corridors.
