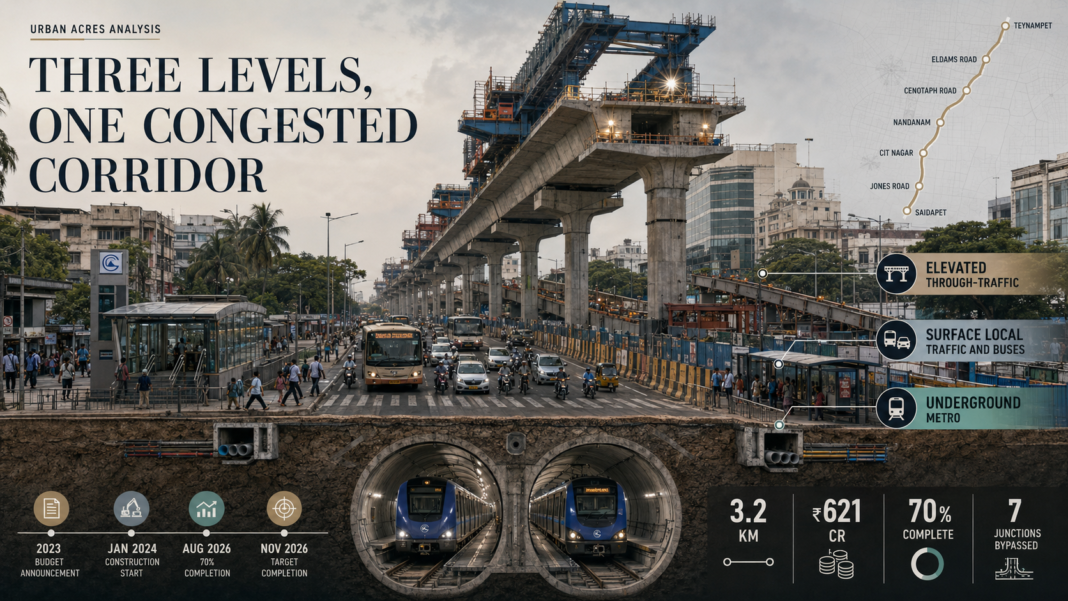

Standfirst: The Anna Salai elevated corridor is targeting a November opening after reaching 70% completion, but lasting congestion relief will depend on the surface road, metro access and junctions at both ends.
The Anna Salai elevated corridor has reached approximately 70% completion, and Tamil Nadu’s Highways Department is targeting the end of November 2026 for opening the four-lane connection between Teynampet and Saidapet. The 3.2-km structure is being assembled over one of Chennai’s most heavily used arterial roads while the operational Blue Line metro continues beneath it.
The project is significant because the city is trying to occupy a third transport layer without disabling the other two.
At street level, Anna Salai carries buses, cars, two-wheelers, pedestrians and local turning traffic. Beneath the road, Chennai Metro trains operate through Teynampet, Nandanam and Saidapet. Above them, the Highways Department is constructing a four-lane road intended to remove through-vehicles from seven major intersections.
This vertical stacking is the project’s principal engineering achievement—and the reason it is so expensive.
The corridor costs ₹621 crore, equivalent to approximately ₹194 crore per kilometre. TNIE previously described it as Tamil Nadu’s costliest flyover on a per-kilometre basis, compared with approximately ₹95 crore per kilometre for Koyambedu and ₹100 crore for Medavakkam. These comparisons are useful but not perfectly equivalent because the Anna Salai project requires specialised foundations, extensive utility relocation and construction above operational railway infrastructure.
The estimate has also changed substantially. Project documents cited in earlier reporting placed it at ₹482 crore in April 2022, ₹525 crore in March 2023 and ₹621 crore by 2024. That represents an increase of approximately 28.8% from the earliest reported estimate. The available evidence attributes much of the escalation to engineering complexity, soil treatment, utility relocation and structural safeguards for the metro—not to one single cause.
Approximately 2.4 km of the flyover passes directly over the metro alignment. The most difficult portion includes around 460 metres above the Teynampet and Nandanam metro-station structures. To avoid disturbing the tunnels, foundations were reportedly restricted to around seven metres below the road, while the metro lies substantially deeper. Prefabricated steel piers, portal frames, pier caps and girders are being used to reduce construction activity and structural loading at the site.
Around 15,000 tonnes of steel components are being manufactured in Gujarat and Telangana and then transported to Chennai. Reinforced-concrete deck units approximately 15 metres long are also fabricated away from the corridor and placed over the steel girders. Off-site fabrication reduces the duration of certain road-level activities, but it makes project progress dependent on manufacturing labour, transport scheduling and limited installation windows in Chennai.
That dependency contributed to the latest delay. The project was originally expected to be completed in September 2026. Highways officials said workers involved in steel fabrication returned home during the April election period and did not immediately return, slowing production. At the Chennai site, major construction is permitted for only about six hours at night, further restricting installation time.
The November target should therefore be treated as achievable but not guaranteed.
The latest report says approximately 1.9 km of the 3.2-km flyover is physically complete. That is around 59% of the corridor length, although overall project progress is placed at 70% because the calculation also includes foundations, pier construction, fabrication and other activities. Forty-six of a reported 69 piers had been erected by August 1.
There is, however, a published quantity inconsistency. Earlier reporting based on official documents described 91 piers in total: 69 associated with the metro-alignment section and 22 on the non-metro stretch. The latest report describes 69 as the total. This may reflect different counting conventions involving individual piers and portal-frame systems, but an official project status sheet is required before either figure is treated as definitive.
The projected mobility benefit is substantial. The latest estimate says the elevated road could reduce travel between Teynampet and Saidapet from around 30 minutes to five minutes by bypassing Eldams Road, SIET College Road, Cenotaph Road, Nandanam, CIT Nagar, CIT Nagar First Main Road and Jones Road. Earlier project reporting used a different baseline—40 minutes reduced to 10 minutes.
The variation does not necessarily invalidate the forecast. Travel time changes by direction, time of day and measurement point. It does show why opening-day claims must be replaced by independently measured data.
A reliable evaluation should record:
- median and worst-case journey times before and after opening;
- queue length at the Teynampet and Saidapet ramps;
- travel time on the surface road;
- bus journey reliability;
- traffic on parallel streets through T. Nagar and CIT Nagar;
- collision and breakdown frequency;
- and pedestrian crossing time.
Without these measurements, a faster trip on the elevated road could conceal slower movement elsewhere.
Flyovers remove signal delay for one stream by separating it from cross-traffic. Vehicles using the elevated road will avoid seven intersections. Local vehicles, buses, pedestrians and turning traffic will continue using the road beneath.
This creates two possible outcomes.
In the stronger outcome, through-traffic shifts upward, leaving the surface road less congested. Buses become more reliable, crossings become safer, footpaths can be widened and metro entrances become easier to reach.
In the weaker outcome, the space released beneath the flyover is absorbed by additional cars, parking, informal stopping and unmanaged turning movements. Junction congestion then relocates to the ramps and the corridor returns to saturation after an initial period of relief.
International urban-transport guidance consistently cautions that road-capacity expansion alone is not a durable congestion strategy. It must be combined with high-capacity public transport, walking, traffic management and measures that improve the efficiency of the complete street network.
Anna Salai already contains the infrastructure necessary for that integrated approach. Teynampet and Nandanam metro stations have entrances on both sides of the road, connections to nearby bus stops, lifts and escalators. The road is therefore not merely an automobile artery. It is the street-level access system for an operational rapid-transit line.
The post-construction restoration plan should prioritise these interfaces.
Pedestrians should be able to move continuously between bus stops, metro entrances, offices, hospitals and intersecting streets. Crossings should remain at natural walking routes rather than being displaced solely to maximise vehicle speed. Lighting beneath the structure, drainage, visibility, universal accessibility and protection from unauthorised parking will determine whether the space feels usable after dark and during the monsoon.
This matters because flyover construction can leave behind a residual urban space: columns, shadows, turning lanes and fragmented walking paths. Without deliberate design, the area beneath becomes a transport void rather than public infrastructure.
Anna Salai’s traffic mix also requires bus planning. If through-cars move to the flyover while buses remain below, the project could improve public transport by reducing junction queues. But this benefit depends on bus stops being positioned outside merge conflicts and on private vehicles not occupying stopping areas.
The Highways Department, GCC, MTC, Traffic Police and CMRL should therefore publish one integrated surface-road operating plan before opening. It should show:
- bus-stop locations;
- metro-entry access routes;
- U-turn and right-turn movements;
- loading and parking restrictions;
- pedestrian crossings;
- ramp merge areas;
- emergency access;
- and drainage arrangements.
The two ramp zones are especially important. An elevated road cannot carry more traffic than its entry and exit network can absorb. If vehicles descending at Saidapet encounter queues near Jones Road, the bridge may operate efficiently while the downstream road does not. Similarly, congestion can develop at Teynampet when vehicles merge with traffic approaching Gemini and central Chennai.
Traffic management must therefore cover a larger area than the 3.2-km project boundary.
The environmental case is similarly conditional. Reduced idling at seven junctions could lower local fuel consumption and emissions. But increased road capacity may change route choice and attract trips from parallel streets. If the corridor encourages additional car travel while buses and metro access remain unchanged, part of the initial benefit will be lost.
The strongest environmental return would come from using the flyover to reorganise the surface road in favour of high-occupancy and low-emission movement. That means reliable buses, protected pedestrian access, safer cycling where feasible and direct links to metro entrances.
Cost accountability must continue after construction.
At ₹621 crore, the flyover represents a major public investment in a short section of road. Its unusual engineering may justify a large premium, but the government should publish the final cost, contract variations, quantity changes and independent structural-safety certification. It should also clarify the conflicting published pier counts and tunnel-depth descriptions.
This is not merely a financial-audit issue. Clear engineering information is necessary because the flyover and metro are physically interdependent. Long-term monitoring must cover settlement, structural movement, drainage, corrosion, bearing condition and any effect on the underground railway assets.
The project also demonstrates an important limit of percentage-completion reporting. “Seventy per cent complete” does not reveal whether the remaining 30% consists of repetitive work or the most difficult spans, portal frames, ramps, safety barriers, road surfacing and testing. The critical path—not the average percentage—determines whether November is realistic.
Before commissioning, the corridor will require completion of structural connections, deck work, barriers, expansion joints, lighting, drainage, road surfacing, markings, signs, load testing and traffic-safety inspection. The available public information does not provide a milestone-by-milestone schedule for these activities.
The evidence supports the Highways Department’s case that the corridor responds to an exceptionally difficult engineering and congestion problem. It does not yet establish that the flyover will permanently reduce corridor-wide congestion or deliver the projected five-minute trip.
What the evidence does not yet show is the final surface-road design, the expected traffic volume on the flyover, the capacity of its ramp junctions or how benefits will be divided among cars, buses, metro passengers and pedestrians.
The Anna Salai elevated corridor should therefore be evaluated at three levels.
The first is structural performance: was it built safely above an operational metro system?
The second is traffic performance: did it reduce journey time and improve reliability without creating new bottlenecks?
The third is urban performance: did it produce a safer and more accessible Anna Salai for the people who remain at street level?
Opening the road in November would complete the construction phase. Only transparent before-and-after data will determine whether it completes the mobility objective.
