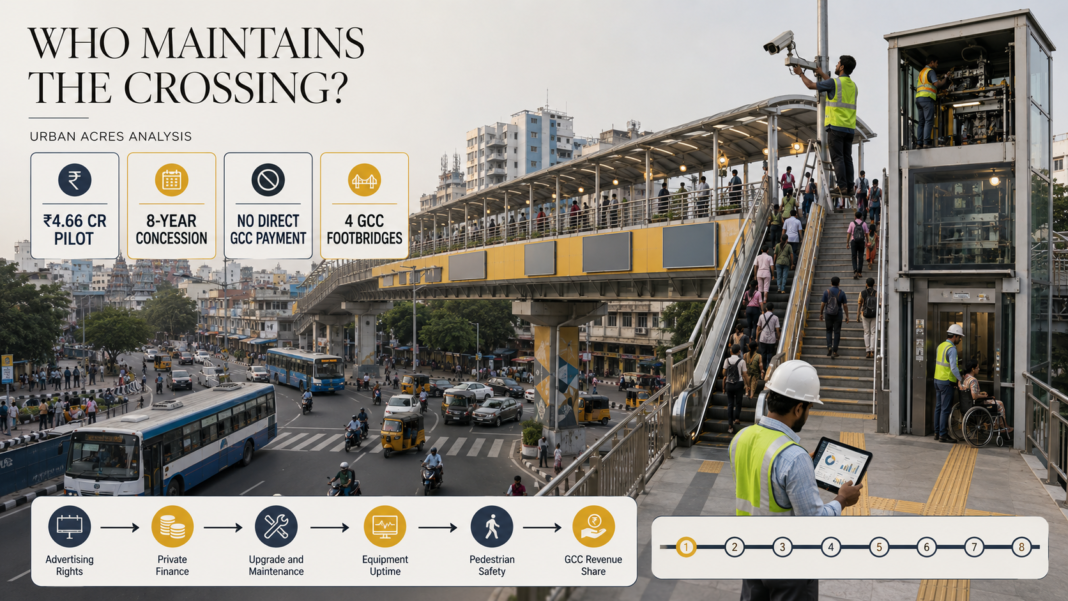

The Greater Chennai Corporation proposes to exchange eight years of advertising rights for private investment and maintenance at the Taluk Office Road foot overbridge. Whether the model works will depend less on the advertisements than on lifts, lighting, cleaning and uninterrupted pedestrian access.
The Greater Chennai Corporation is testing a new approach to maintaining pedestrian infrastructure.
Under a pilot public-private partnership, a private concessionaire will design, finance, modernise, operate and maintain the Taluk Office Road foot overbridge for eight years. The project is estimated at ₹4.66 crore. GCC will make no direct project payment; the operator will commercially use approved advertising spaces and share part of the resulting revenue with the corporation.
The proposal addresses a genuine municipal problem.
A modern foot overbridge is no longer only a steel or concrete structure. It can contain lifts, escalators, ramps, tactile surfaces, electrical systems, CCTV cameras, lighting, drainage, roofing, communication systems and emergency equipment. Each component has a different maintenance cycle.
When a light fails, the bridge can feel unsafe after dark.
When drainage fails, water can damage electrical and mechanical systems.
When a lift fails, the bridge becomes inaccessible to many disabled and older users.
When cleaning and security fail, usage declines even if the structure remains technically open.
GCC’s planned intervention includes ramps, lifts, escalators, tactile paving where required, energy-efficient lighting, CCTV and remote monitoring. The project therefore recognises that operating the facility is as important as upgrading it.
This Is Not Free Infrastructure
The statement that GCC will not pay the concessionaire should not be interpreted as meaning the project has no public cost.
The corporation is granting commercial access to a civic asset for eight years. Advertising rights possess monetary value. The operator will use that value to recover capital expenditure, maintenance cost, financing, energy, staffing and profit while also sharing revenue with GCC.
The transaction is therefore:
private capital and maintenance in exchange for public advertising rights.
The relevant question is not whether GCC writes a cheque. It is whether the public receives more lifecycle value than the commercial rights it grants.
That assessment cannot yet be completed because the revenue-sharing percentage remains undisclosed. The available report also does not identify a minimum guaranteed concession payment, permissible advertising area or the mechanism for auditing advertising receipts.
A ₹4.66-crore project spread arithmetically over eight years equals approximately ₹58.25 lakh a year before financing and operating expenditure. That is only a scale indicator, but it demonstrates why advertising inventory and footfall will materially influence bidder interest.
If advertising revenue performs below expectation, the operator must still maintain the lifts, lighting and structure.
The contract cannot allow reduced advertising income to become a defence for reduced public service.
The Location Must Be Corrected
The triggering report describes the pilot as being on Taluk Office Road in Anna Nagar.
GCC’s official bridge inventory places the Taluk Office Road foot overbridge in Zone XIII, Ward 171. Historical reporting identifies the structure near the Saidapet court complex at Little Mount.
Anna Nagar has a different foot overbridge near the western bus depot, associated with the State Highways Department and repeatedly reported for escalator-maintenance failures.
Until GCC formally identifies the pilot asset, responsible reporting should use the neutral formulation Taluk Office Road foot overbridge and avoid attaching an incorrect neighbourhood.
The discrepancy is not trivial. Project location determines:
- the responsible zone;
- pedestrian demand;
- road authority;
- nearby public-transport connections;
- advertisement value;
- and the relevance of local maintenance history.
Why the PPP May Improve Maintenance
GCC currently maintains four foot overbridges. Routine bridge maintenance is assigned to the zones, while specialised structural work is handled by the Bridges Department.
That division can produce fragmented responsibility.
A zonal team may handle cleaning or minor repairs. A different department may address structural defects. Separate contracts may cover elevators, escalators, lighting or CCTV. Failure can persist while agencies establish which budget or contractor is responsible.
A single lifecycle concessionaire can reduce this fragmentation.
The operator can be made responsible for:
- daily cleaning;
- lift and escalator maintenance;
- lighting;
- electrical systems;
- drainage;
- CCTV;
- security support;
- minor civil repairs;
- structural inspections;
- signage;
- and complaint response.
The potential advantage is not merely private-sector participation. It is one accountable entity across the complete pedestrian experience.
GCC had already explored contractor-based bridge maintenance in 2018, when it sought regional contractors to carry out periodic work instead of issuing separate small contracts for individual assets.
The new proposal goes further. It combines capital investment, operations, maintenance and commercial revenue within one eight-year arrangement.
Long-Term Contracting Does Not Guarantee Long-Term Performance
The same structure creates substantial risks.
The private operator may prioritise advertisement sales because advertising generates revenue, while cleaning, accessibility and repairs generate cost.
GCC must therefore prevent the commercial component from dominating the public function.
Tender conditions reportedly require advertisements to meet safety, structural and aesthetic standards and not interfere with pedestrian movement or motorists’ visibility.
Those principles need measurable enforcement.
The contract should specify:
- maximum advertising area;
- approved materials and structural load;
- digital-display brightness;
- animation and refresh restrictions;
- minimum distance from traffic signals;
- sightline protection;
- emergency and public-information space;
- prohibition on narrowing the walkway;
- and removal deadlines for illegal or damaged displays.
Any digital display should fail safely during a malfunction. It should not create glare or rapidly changing imagery facing moving traffic.
The corporation should also retain space for public information, emergency messages and civic campaigns without additional commercial payment.
Accessibility Must Be Measured Through Uptime
Installing a lift does not make a structure accessible when the lift is repeatedly unavailable.
Chennai’s wider experience demonstrates this risk. Escalators at several pedestrian bridges have been reported non-functional because of water ingress, inadequate maintenance, energy costs or delayed repairs.
The PPP contract should therefore include availability standards.
Possible performance indicators include:
| Component | Required measurement |
| Lift | Percentage of operating hours available |
| Escalator | Availability by direction and time |
| Lighting | Percentage of fixtures functioning |
| CCTV | Camera and recording uptime |
| Walkway | Clear width and obstruction-free status |
| Cleaning | Inspection score and frequency |
| Drainage | Water-clearance time after rain |
| Complaints | Response and closure time |
| Structural condition | Inspection schedule and defect closure |
| Emergency systems | Test frequency and response readiness |
GCC should determine the exact standards through the tender and publish monthly results.
A breakdown affecting accessibility should attract a stronger penalty than a minor cosmetic defect. Repeated failure should trigger step-in rights, replacement of the maintenance subcontractor or termination.
Electricity Cannot Become an Accessibility Variable
Lifts, escalators, CCTV and lighting create a continuing electricity liability.
The contract must state who pays the energy bill, how consumption is measured and what happens after tariff increases.
This matters because escalator operating hours at other Chennai pedestrian facilities have reportedly been restricted in response to electricity costs.
A lift or escalator cannot be advertised as a public facility and then switched off during required operating hours to protect the operator’s commercial margin.
The concessionaire should price energy risk into the bid, subject to whatever indexation mechanism the contract allows.
Energy efficiency can reduce cost through LED lighting, sensors and efficient motors. It cannot replace minimum accessibility obligations.
Remote Monitoring Requires a Response System
The proposal includes CCTV and remote monitoring.
Remote monitoring can detect:
- lift failure;
- escalator stoppage;
- power interruption;
- water ingress;
- unauthorised occupation;
- vandalism;
- congestion;
- and security incidents.
But monitoring is useful only when an identified team must respond.
GCC should require:
- a 24-hour control-room protocol;
- automatic equipment alerts;
- logged response times;
- escalation to civic and emergency agencies;
- preservation and deletion rules for CCTV footage;
- cybersecurity protections;
- and public contact information at the bridge.
CCTV ownership and data access must remain clearly defined. Commercial operators should not receive unrestricted rights to use pedestrian footage for advertising analytics or unrelated purposes.
Usage Must Be Studied Before Commercial Design
Foot overbridges do not automatically improve pedestrian safety merely because they separate people from vehicles.
Earlier Chennai field reporting found that several FOBs were lightly used because their placement, access and additional walking distance did not match pedestrian desire lines. People continued to cross at road level.
The Taluk Office Road structure was originally associated with a busy crossing near the Saidapet court complex, where pedestrians had difficulty negotiating traffic. Historical reporting also recorded public concern over pedestrian safety on the corridor.
Modernisation should begin with current evidence:
- pedestrian counts by hour;
- origin and destination patterns;
- age and mobility profile;
- at-grade crossing behaviour;
- bus and metro interchange demand;
- travel-time comparison;
- perceived safety;
- and reasons for non-use.
If pedestrians avoid the bridge because the entrances are misplaced, adding advertisements and CCTV will not solve the fundamental problem.
The concessionaire should not be rewarded only for keeping the asset technically open. GCC should monitor actual use and investigate persistent avoidance.
At-Grade Safety Remains Necessary
A foot overbridge should not become the justification for removing every safe ground-level crossing.
Some people cannot use long ramps, stairs or lifts that may be unavailable. Emergency evacuation can also require alternatives.
The appropriate crossing system depends on traffic speed, road width, signal operation, pedestrian volume and local destinations.
Where an at-grade crossing is retained, it should be designed and enforced safely. Where the footbridge is the principal crossing, its approaches must correspond to where people actually need to walk.
Pedestrians should not be forced to travel hundreds of additional metres so that vehicle flow remains uninterrupted.
The Contract Must Protect the Asset at Handback
Eight years is long enough for lifts, escalators, roofing, finishes and electronic systems to experience substantial wear.
Without a handback standard, the operator may reduce replacement expenditure near the end of the concession and return a deteriorated asset to GCC.
The agreement should require:
- independent condition surveys during the final years;
- remaining-useful-life standards;
- replacement of worn equipment;
- resolution of structural defects;
- transfer of warranties and maintenance records;
- removal of unauthorised advertisements;
- and a funded handback reserve or performance security.
The final two years should receive enhanced audits rather than reduced oversight.
Scaling Should Depend on Verified Results
GCC says the model may be extended to its other three foot overbridges depending on the pilot’s outcome.
The pilot therefore represents 25% of GCC’s existing FOB portfolio.
Success should not be defined only by whether a bidder participates or whether GCC earns advertising revenue.
The pilot should pass five tests:
1. Accessibility
Are lifts, escalators and ramps consistently available?
2. Safety
Does the bridge remain structurally sound, well-lit and free from dangerous advertising?
3. Use
Do more pedestrians use the bridge, particularly vulnerable users?
4. Financial value
Does the public receive adequate investment, service and revenue for the commercial rights granted?
5. Accountability
Can GCC independently verify performance and intervene rapidly when standards fail?
Only then should the concession be replicated.
What GCC Should Publish
Before awarding the project, GCC should place the following information in the public domain:
- exact asset location;
- tender and concession documents;
- baseline structural audit;
- pedestrian footfall;
- capital-upgrade schedule;
- permitted advertisement inventory;
- revenue-sharing formula;
- minimum guaranteed payment, if any;
- equipment-availability standards;
- energy-cost responsibility;
- CCTV and data policy;
- performance deductions;
- insurance requirements;
- emergency response;
- termination provisions;
- and handback conditions.
After award, the corporation should publish a monthly dashboard.
The evidence supports the decision to seek a lifecycle maintenance solution. Chennai’s pedestrian bridges have repeatedly demonstrated that constructing lifts and escalators is easier than keeping them reliably operational.
What the available evidence does not yet establish is whether the advertising concession offers fair value, whether the location has been correctly identified, or what service standards the private operator must meet.
A successful PPP should make the footbridge feel like dependable public infrastructure.
It should not merely make the structure commercially visible.
