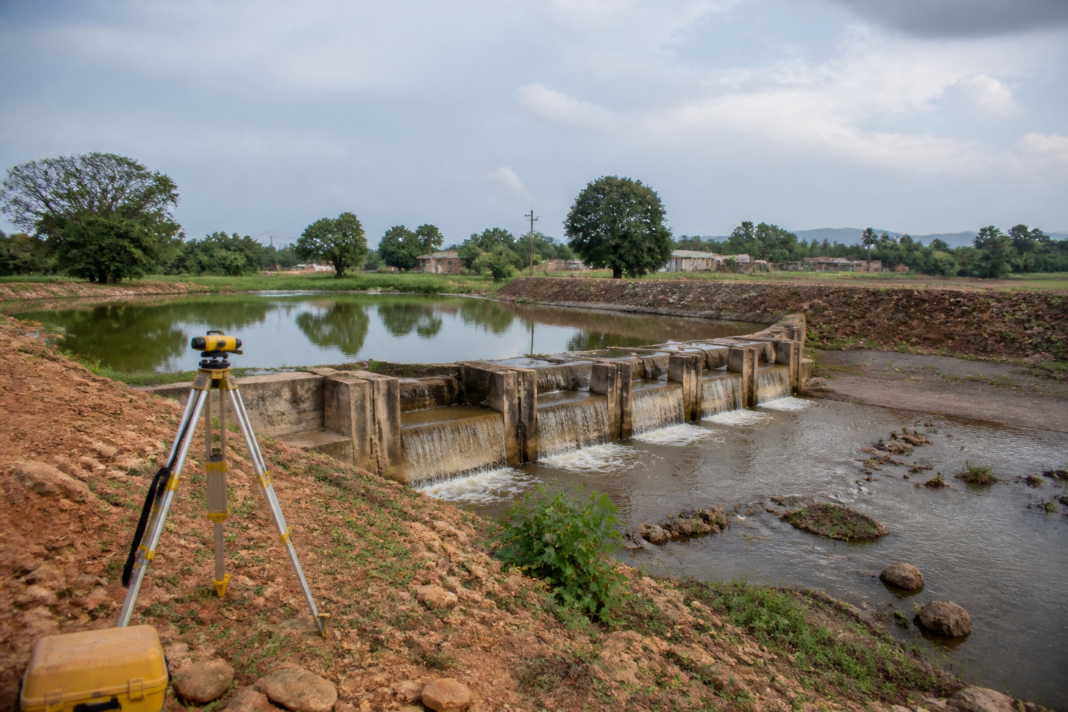

A Comptroller and Auditor General (CAG) audit has exposed how Odisha’s check-dam programme could spend ₹4.26 crore on seven structures at locations where dams were already present, raising a larger question about whether digital verification is being used to prevent duplication or merely recorded after decisions have been made. The finding concerns the Mukhyamantri Adibandha Tiari Yojana (MATY), a state scheme intended to improve irrigation and recharge groundwater through small water-retention structures.

The audit’s significance extends beyond the seven sites. Check dams are relatively small pieces of infrastructure, but they sit inside a chain of public decisions involving site selection, technical estimates, contracts, supervision, measurement, payment and post-construction verification. If a structure that is already visible on the ground and in satellite imagery can receive a fresh construction agreement, the problem is not limited to one potentially duplicated asset. It points to a breakdown between data collection, administrative approval and financial control.

The CAG examined 331 of 481 check dams constructed in 12 sampled minor irrigation divisions. It cross-verified their locations using Google Earth Pro and geo-tag credentials supplied by the water resources divisions. Seven check dams in four divisions were found by the audit to have already existed when fresh construction contracts were awarded. Expenditure of ₹4.26 crore was incurred between April 2023 and January 2025 for the construction of the seven structures, according to the report cited by The Times of India.

The report was a compliance audit for the year ended March 2024 and was tabled in the Odisha Assembly on Monday, according to the source report. Its central concern was not simply that old structures may have been mistaken for new ones. The audit said fresh agreements were executed and public money released despite the department having already directed the geo-tagging of check dams in 2022. That direction was intended to help identify existing structures and prevent duplication.

The apparent contradiction is at the heart of the case. The department had a mechanism that could record the location of infrastructure. The audit also had access to location data and satellite imagery sufficient to identify structures that predated the new agreements. Yet the presence of geo-tagged information did not prevent the subsequent approval and payment process from moving forward.

This distinction matters because geo-tagging is often presented as a solution to weak monitoring. A photograph, coordinate or digital record can make an asset easier to locate, but it does not by itself establish who checked the information, when the check took place, what decision followed from it, or who was accountable when the record conflicted with a proposed estimate. In this case, the audit’s finding suggests that the data existed without becoming an effective administrative gate.

The government’s response, as reported, illustrates the difficulty of converting visual evidence into a clear project history. Officials stated that some of the structures identified by the audit had been constructed earlier and were visible in Google images before new agreements were executed. In one case, the government argued that the structure visible in satellite imagery was an earthen bund built by local people. It also disputed one of the locations identified by the audit.

Those explanations raise a legitimate technical question: not every bund or water-retention structure visible in an image is necessarily the same as a formally sanctioned check dam. A local earthen bund may differ in design, ownership, engineering standard or intended function from a structure approved under MATY. But the audit rejected the explanation in the circumstances it examined. It noted that the concerned superintending engineers had executed fresh agreements and made payments for new check dams at those locations.

The audit also observed that the estimates did not mention the replacement of older structures. That detail is important. If the department intended to dismantle, upgrade or replace an existing asset, the project documents would need to establish that distinction. Without such a description in the estimates, a payment for a “new” check dam becomes difficult to reconcile with evidence that a structure already stood at the same site.

The case therefore exposes a documentation problem as much as a construction problem. A public works project is not verified only by its physical presence. The records must establish what was approved, what was built, whether the work was new or a replacement, what quantity was measured and why payment was justified. When those categories are blurred, the same physical structure can appear in multiple administrative narratives.

When digital monitoring does not become control

The MATY episode shows the limits of technology without institutional sequencing. Geo-tagging can create a baseline inventory, while satellite imagery can provide an additional way to examine whether a site already contains a structure. But the system becomes meaningful only when the inventory is consulted before a technical estimate is prepared, before an agreement is signed and before payment is authorised.

The supplied audit findings do not establish why the seven projects passed through each of those stages. They do, however, establish that geo-tag coordinates used for verification were supplied by the department itself, and that the audit found existing structures at sites selected for fresh construction. This creates a clear accountability gap between the information available to the department and the action taken by its officials.

The institutional chain is especially important in minor irrigation works because responsibility is distributed. A field-level official may identify a location. A technical officer may prepare or approve an estimate. A contracting authority may execute an agreement. Engineers may certify progress, while higher-level officers oversee payments. A digital record can assist every stage, but it does not replace the need for each stage to record its own verification.

The audit’s reference to the role of superintending engineers brings that chain into focus. The report said these officials executed fresh agreements and made payments for new check dams at the locations identified. That does not, by itself, determine criminal liability; the audit used the language of a “possibility of fraudulent payments” and called for investigation by appropriate authorities. But it does identify a decision point at which the existence of an earlier structure should have been addressed.

This is also why the issue should not be reduced to whether satellite imagery is accurate. The audit used Google Earth Pro and geo-tag credentials as part of its cross-verification, while the government disputed some interpretations. The stronger administrative question is whether field inspection, technical records and imagery were reconciled before contracts were awarded. A resilient verification system should be able to distinguish a new structure from an old one, a replacement from duplication, and a community-built bund from a sanctioned public asset.

The water infrastructure question

Check dams are designed to serve practical water-management functions, including improving irrigation facilities and recharging groundwater. Their scale may be modest compared with large reservoirs or canals, but their value depends on correct siting and additionality. A new structure should add capacity, improve water retention or replace an unusable asset. Spending on an existing structure without documenting a distinct intervention weakens that public purpose.

The audit findings also reveal why the quality of small infrastructure records matters for larger water policy. A government cannot reliably assess the reach of an irrigation programme if it is uncertain how many structures were actually built, where they are located, whether they are new, and whether the expenditure corresponds to a distinct physical outcome. The problem is not only financial. It affects the accuracy of planning and the credibility of claims about groundwater recharge and irrigation access.

The available material does not provide a complete assessment of MATY’s overall performance, nor does it establish whether the seven structures were usable, redundant or technically deficient. It identifies seven cases within the audit sample and records the government’s response. Those limits are important. The findings should not be extended to every check dam under the scheme without further evidence.

At the same time, the sampled cases are sufficient to expose a systemic vulnerability. The audit reviewed 331 structures from a larger set of 481 in 12 sampled minor irrigation divisions. Within that sample, it identified seven locations where existing structures were found before fresh agreements were executed. The percentage alone cannot determine the extent of irregularity across the entire programme, but the pattern is serious because it occurred despite a department-level geo-tagging direction.

The next question is whether the state’s response will remain a dispute over individual locations or become a review of the underlying control system. The audit has already pointed to several elements that require examination: the original construction dates of the structures, the timing of the geo-tags and satellite images, the contents of the technical estimates, the basis for certifying work, the officials who approved agreements and payments, and whether any work was actually carried out at the seven sites.

The CAG has not itself determined that fraud occurred. It has flagged the possibility of fraudulent payments and said the matter should be investigated by appropriate authorities. That distinction must be preserved. An audit observation is a serious accountability trigger, but a finding of criminal wrongdoing would require investigation and due process.

What the evidence does confirm is a failure of assurance. Existing structures were visible through material later used by the audit; the department had directed geo-tagging to prevent duplication; fresh agreements were nevertheless executed; and ₹4.26 crore was paid for seven check dams identified in four divisions. The government has offered explanations for some cases, but the audit rejected them and noted that the project estimates did not describe replacement work.

For Odisha’s water infrastructure, the immediate institutional test is therefore not the adoption of another monitoring tool. It is whether the state can connect its existing records to binding decisions before money moves. The outcome of any investigation, the treatment of the seven contracts and the steps taken to reconcile the geo-tagged inventory with project approvals will determine whether MATY’s digital safeguards become operational controls or remain records that are consulted only after an audit identifies a problem.
