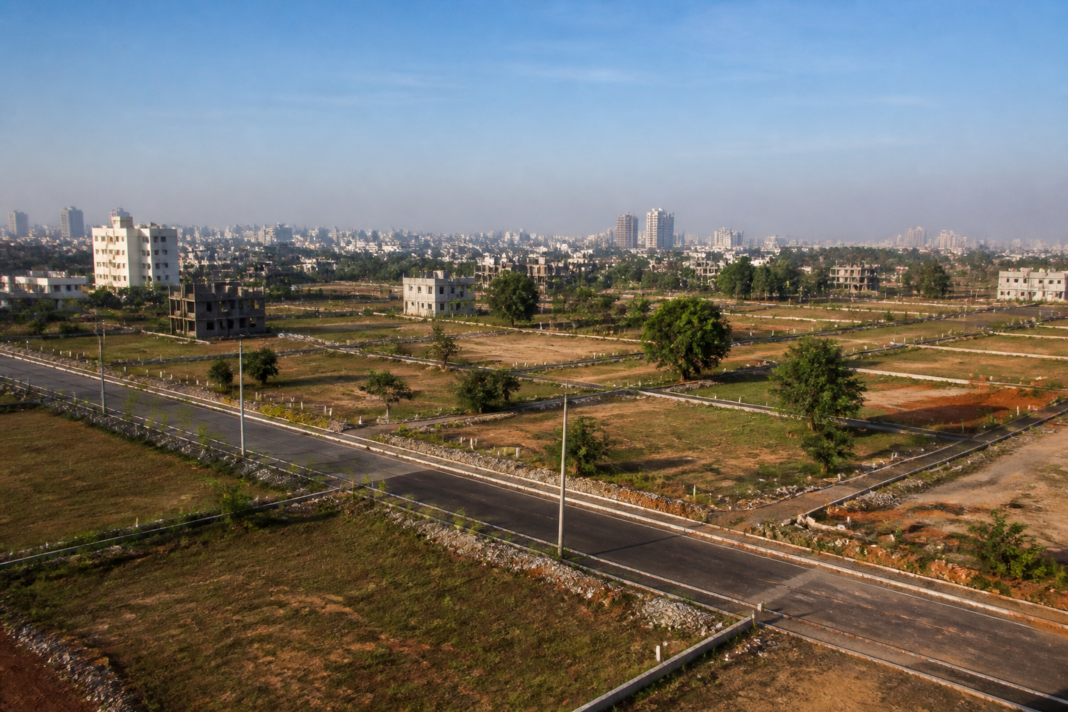

Bengaluru’s Arkavathy Layout was conceived as one of the Bangalore Development Authority’s major housing projects. More than two decades after the first land-acquisition notification, however, the layout remains defined by a basic gap between allotment and delivery: 1,119 original allottees are still waiting for site registration, according to data cited in a report by Vijay Karnataka.
The case is not simply about a delayed housing project. It illustrates how urban land acquisition can lose momentum when planning ambition, legal claims, farmer resistance and administrative decisions pull the project in different directions. Arkavathy Layout was initially planned on a much larger land base, but the area available to the BDA was reduced substantially through litigation, exclusions and voluntary withdrawal from acquisition. The result was a project in which the authority could not provide the number of sites originally intended, while many allottees remained tied to a process that had begun years earlier.
The BDA first issued a preliminary notification on February 3, 2003, proposing to acquire 3,839 acres and 12 guntas for the layout. The project was intended to provide approximately 20,000 sites. But the acquisition process encountered legal challenges and protests by landowners and farmers. By the time of the revised final notification in 2014, the land covered by the project had fallen to 1,766 acres and seven guntas, according to the reported figures.
That reduction changed the project’s capacity. In 2006, the BDA was able to allot only 8,711 sites, far below the original plan. The authority collected Rs 225.02 crore in revenue from the sites that were allotted, while the delivery of land to beneficiaries continued to depend on the outcome of disputes and the availability of legally usable parcels.
The figures show both partial progress and a persistent administrative shortfall. BDA data cited by the report indicate that sites belonging to 3,976 allottees have been registered. At the same time, 3,090 alternative sites have been allotted in the Nadaprabhu Kempegowda Layout because land was not available in Arkavathy Layout. A further 631 allottees had not paid for the sites allotted to them. These categories do not describe a single uniform beneficiary experience: some allottees have received registered sites, some have been shifted to another layout, some have not completed payment, and 1,119 original allottees continue to await registration.
The use of alternative sites is an administrative response to land scarcity, but it also reveals the limits of treating a layout as a fixed promise when its land base remains unsettled. A substitute site may provide a practical route for some beneficiaries, but it does not erase the original dispute over location, timing, eligibility or the terms under which the allotment was made. The reported BDA position is that it has continued efforts to provide sites to the remaining allottees despite the prolonged legal dispute and that more sites may become available in the Arkavathy design once the cases are resolved.
The government’s account of the land position provides the clearest explanation for why the project has not proceeded as originally planned. In a written response to a question in the legislature, Deputy Chief Minister D.K. Shivakumar stated that, of the 2,750 acres included in the final notification of February 23, 2024, 983 acres and 33 guntas had been excluded from acquisition through the revised notification issued in 2014. The response also recorded that the High Court had cancelled notifications covering 83 acres and eight guntas in different cases.
The BDA itself relinquished another 198 acres and 20 guntas under Section 48(1) of the Land Acquisition Act, 1894, according to the government response cited in the report. A further 702 acres and five guntas were excluded from the revised final notification in light of High Court writ appeals and Supreme Court guidelines. Taken together, these changes show why the initial land estimate could not be translated into a corresponding number of completed sites.
The legal dimension is therefore not a peripheral complication. It is central to the project’s outcome. Land acquisition creates a chain of administrative actions: preliminary notification, objections, final notification, compensation and possession, layout formation and eventual registration. If any link is challenged or cancelled, the authority may have to redraw the layout, remove parcels, identify substitute land or defer registration. For beneficiaries, the process can appear stalled even when the authority is continuing with parts of the project.
The report states that landowners have filed cases in court and that the overall process is being heard by the Justice K.N. Keshavanarayana Committee. The state government has attributed the delay in site registration to these legal proceedings. That explanation establishes the immediate cause cited by the authorities, but it also raises a larger governance question: how should public agencies communicate the status and risks of large housing layouts when acquisition remains legally vulnerable?
A public housing allotment is generally understood by a beneficiary as a route to a defined asset. Yet the Arkavathy experience demonstrates that an allotment can remain conditional for years when the authority has not secured uncontested land for every promised site. The difference between an allotment record and a registered site becomes particularly important in large urban projects. The former reflects an administrative decision; the latter requires the land, title and legal process to align.
The site prices reported for Arkavathy Layout also indicate the range of commitments involved. The listed prices included Rs 1,13,900 for a 6-by-9-metre general-category site, Rs 56,700 for a 6-by-9-metre economically weaker section site, Rs 2,27,300 for a 9-by-12-metre site, Rs 4,54,600 for a 12-by-18-metre site and Rs 7,58,500 for a 15-by-24-metre site. These figures are part of the original allotment framework, but the continuing delay means beneficiaries have had to deal with an uncertain timeline for converting that framework into ownership and use.
The project also offers a planning lesson about scale. The BDA’s original intention to create 20,000 sites depended on acquiring nearly 3,840 acres. When the available area contracted to roughly 1,766 acres by the revised notification stage, the authority’s ability to maintain the original supply target necessarily diminished. The reduction was not caused by a single planning adjustment; it emerged from court decisions, landowner litigation, statutory withdrawal and revised government action.
This is why the Arkavathy dispute cannot be assessed only by counting registered sites. The 3,976 registrations and 3,090 alternative allotments show that the BDA has delivered outcomes for many beneficiaries. But the 1,119 people still awaiting registration represent the unresolved portion of the project, and their position is tied to the eventual legal status of the remaining land and the administrative decisions that follow.
The case also underscores the institutional complexity of urban land development in Bengaluru. The BDA is responsible for planning and implementing the layout, but landowners, courts, the state government, legislative oversight and beneficiary decisions all influence the outcome. A court order can alter the land pool; a government notification can exclude parcels; an authority can withdraw from acquisition; and an allottee can either accept an alternative site or defer payment. The final shape of the neighbourhood emerges from these overlapping decisions rather than from the original plan alone.
What the available evidence confirms is that Arkavathy Layout has moved far beyond an ordinary construction delay. Its central problem is the inability to match allotment commitments with a stable, legally available land base. What remains uncertain is the timetable for resolving the pending cases, the number of additional sites that could become available after the legal process, and the precise route for the 1,119 original allottees who have not yet received registration.
The next significant developments will depend on the proceedings before the Justice K.N. Keshavanarayana Committee, the status of the court cases and the BDA’s response once the legal position becomes clearer. Until then, Arkavathy Layout remains a continuing example of how the legal foundations of urban land acquisition can determine whether a housing promise becomes a registered property or remains an unresolved allotment.
