HomeLatestMumbai Ahmedabad high speed rail builds 300 km viaduct

Mumbai Ahmedabad high speed rail builds 300 km viaduct

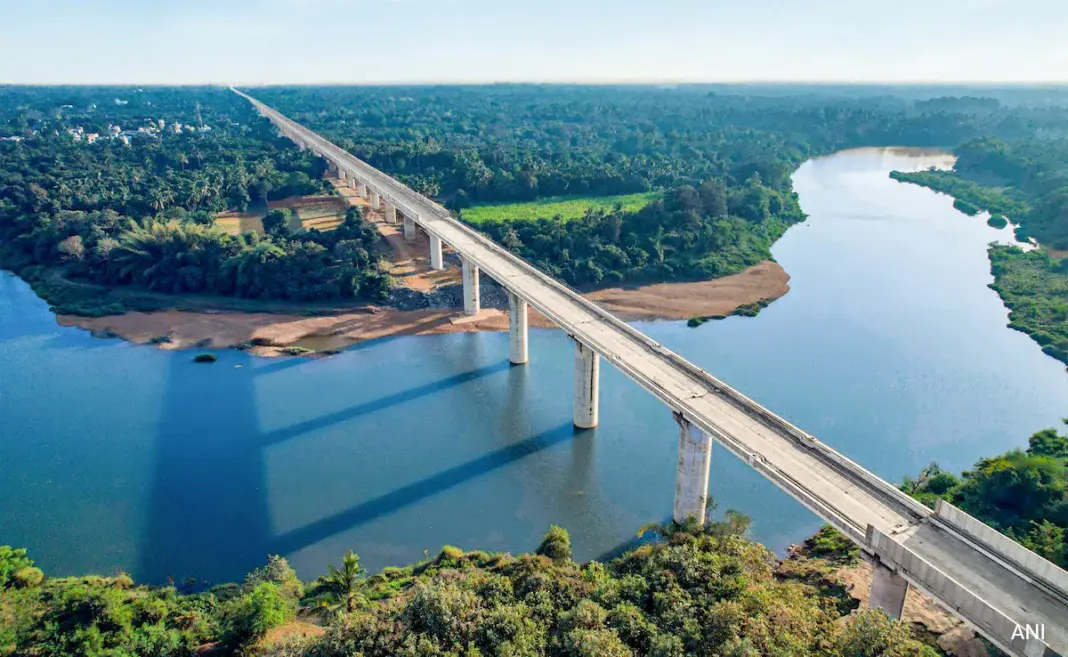

300 kilometres of viaduct superstructure have been completed for the Mumbai–Ahmedabad Bullet Train corridor.

The development marks a major leap in physical infrastructure for what is set to become India’s first bullet train service, promising transformational impacts on regional connectivity, industrial ecosystems, and sustainable mass transit. vThe National High-Speed Rail Corporation Limited (NHSRCL), which is overseeing the construction of the 508-kilometre-long corridor, confirmed the accomplishment with the successful launch of a 40-metre-long full-span box girder near Surat in Gujarat. Officials said this achievement reflects the pace and precision the project has gained, as over half the viaduct length now stands completed.

Of the 300 kilometres built so far, approximately 257.4 kilometres have been executed using the Full Span Launching Method (FSLM), known for its speed and reduced disruption to surrounding areas. The FSLM method, involving the placement of full-span girders weighing nearly 970 metric tonnes each, is said to be up to ten times faster than conventional segmental methods. This approach is being hailed as a benchmark for future infrastructure projects, especially those aligned with rapid transit and sustainable construction goals. A senior official associated with the corridor’s structural planning remarked that adopting FSLM on this scale showcases India’s emerging prowess in megaproject engineering. The FSLM was complemented by the Span by Span (SBS) method used for 37.8 kilometres of viaduct and supplemented by steel and pre-stressed concrete (PSC) bridges covering 0.9 kilometres and 1.2 kilometres respectively. An additional 2.7 kilometres have been integrated into upcoming station structures.

The viaduct comprises an impressive 6,455 spans placed using FSLM and 925 spans using SBS. These elements are being manufactured and transported from 27 purpose-built casting yards set up across the alignment in Gujarat and Maharashtra. Officials confirmed that these yards also support the casting of girders and piers, reinforcing the localised manufacturing ecosystem and thereby reducing the project’s embedded carbon footprint due to limited long-distance transportation of heavy materials. Emphasising local innovation, the NHSRCL noted that most of the construction machinery used in the project, including launching gantries and girder transporters, has been indigenously designed and manufactured. This localisation not only adds resilience to supply chains but also strengthens India’s standing in advanced railway technology development.

The corridor’s infrastructure also includes 14 river bridges and seven steel bridges with spans ranging from 60 to 130 metres. Steel fabrication is being executed across seven workshops in multiple states including Maharashtra, Gujarat, Tamil Nadu, Uttar Pradesh, and West Bengal, reflecting a pan-India collaboration on this critical infrastructure endeavour. Addressing environmental sustainability and livability standards, over three lakh noise barriers have been installed along the completed viaduct sections to minimise the impact on nearby communities. These noise mitigation efforts are aligned with NHSRCL’s commitment to ensure that high-speed rail infrastructure is built with due consideration to social and environmental sensitivities.

Beyond viaduct construction, the project has also achieved key milestones in substructure work. Foundation construction has crossed 401 kilometres, while 383 kilometres of pier work and 326 kilometres of girder casting have been completed. Moreover, the laying of track infrastructure has commenced, with 157 kilometres of reinforced concrete track bed already constructed in Gujarat. Rolling stock depots featuring next-generation facilities are also progressing steadily in both Gujarat and Maharashtra. The stations under construction are being developed as integrated transit hubs that will enable seamless intermodal connectivity with local rail and road transport systems. This vision is aimed at enhancing commuter convenience and boosting last-mile connectivity, which is a crucial component in promoting the shift towards public transport-based urban mobility.

Experts believe that the high-speed corridor will redefine travel between India’s financial capital, Mumbai, and Gujarat’s economic powerhouse, Ahmedabad. The project is being built with Japanese financial and technical assistance, with the transfer of technology a key feature of the bilateral cooperation. Trained engineers, skill development programmes, and local industrial participation are expected to leave a lasting impact on India’s infrastructure sector. The bullet train, when operational, will cover the distance between Mumbai and Ahmedabad in just about two hours, compared to the current travel time of over seven hours by conventional rail. The project aligns with India’s broader goals of carbon-neutral development and efficient mass transit. By shifting intercity travel from road and air to electric high-speed rail, the bullet train corridor is expected to reduce overall greenhouse gas emissions in the region.

As construction advances, officials remain optimistic about achieving critical project milestones within the revised timelines. The corridor, a showcase of both engineering excellence and sustainable planning, is poised to set a precedent for future transport corridors in the country. While delays and land acquisition challenges have plagued sections of the alignment, particularly in Maharashtra, progress in Gujarat remains steady and robust. The on-ground push, complemented by policy support and international expertise, suggests that India’s dream of ultra-fast, low-emission rail travel may soon be a reality.

The Mumbai–Ahmedabad Bullet Train is not merely a transportation project—it is a blueprint for the future of mobility, engineering, and regional equity in a rapidly urbanising nation.
