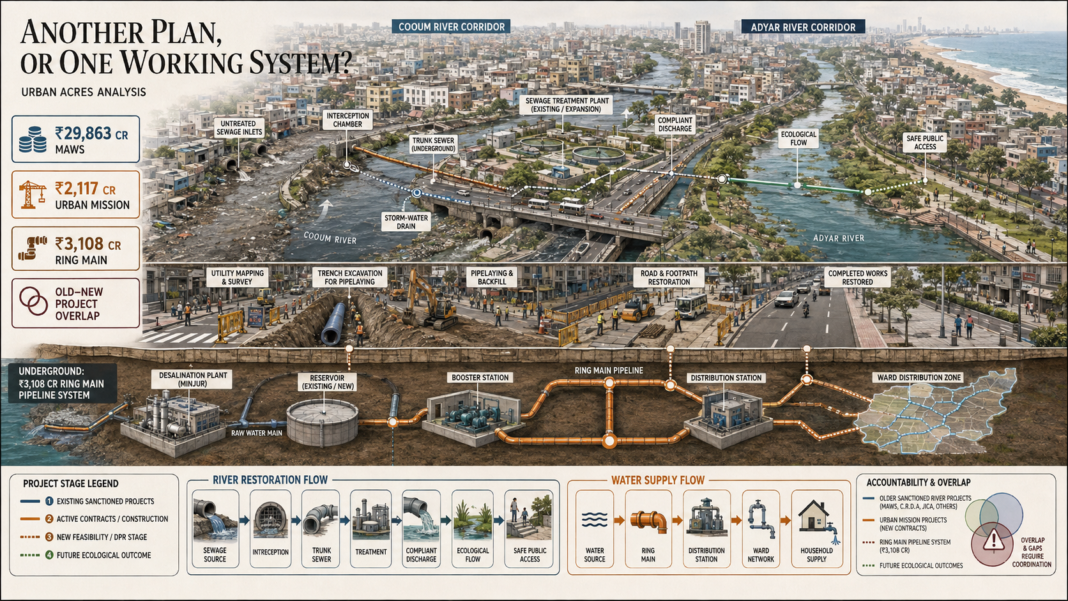

Tamil Nadu has substantially increased its urban-development allocation and placed Chennai’s rivers, drinking-water network, streets and blue-green infrastructure at the centre of the 2026–27 Budget.
The Municipal Administration and Water Supply Department has received ₹29,863 crore, compared with ₹26,678 crore in 2025–26. The Budget also allocates ₹2,117 crore to an integrated urban-development mission covering water, sewerage, waste, roads, mobility, green spaces, public health, social infrastructure and technology-supported governance.
For Chennai, the most politically visible promise is another attempt to restore the Cooum and Adyar rivers.
The government proposes to invite global tenders and prepare a detailed feasibility report and detailed project report. The stated vision is to make the rivers clean enough to support boating, recreation and safe public access along their banks.
That ambition is legitimate.
Its project status requires far greater precision.
Chennai already has river-restoration programmes
The Cooum and Adyar are not entering government planning for the first time.
The Chennai Rivers Restoration Trust records an administratively sanctioned ₹735.08-crore Integrated Cooum River Eco-Restoration Project covering 32 km from Paruthipattu to the river mouth. Its components include sewage interception, channel improvement, solid-waste removal, fencing, vegetation, underground sewerage and rehabilitation, distributed across several public agencies.
CRRT also records an administratively sanctioned ₹744.60-crore Adyar restoration programme from the river’s origin to its mouth. That programme similarly assigns sewage, solid waste, river engineering, underground sewerage, biodiversity and rehabilitation work to different departments.
A further Adyar PPP project was placed before the National Green Tribunal in April 2026. The reported concession includes 14 sewage-treatment plants with 110 MLD of combined capacity, 89 km of trunk sewer along the riverbanks, parks and plantations, a 30-month construction period and 15 years of operation and maintenance.
The new Budget must therefore answer a basic question:
What exactly is being tendered again?
Possible explanations include:
- an independent review of existing schemes;
- preparation of a unified master plan covering previously fragmented projects;
- redesign of projects that have stalled or underperformed;
- expansion beyond existing project boundaries;
- or replacement of an earlier procurement arrangement.
Until government publishes that explanation, the latest announcement should be described as a new planning and project-restructuring exercise, not as the first river-restoration programme.
Sewage removal must precede recreation
The Budget’s vision of boating, children playing near the water and residents exercising along clean riverbanks provides a compelling public image.
It is not yet an engineering standard.
A river can look improved while remaining biologically unsafe. Odour reduction, bank beautification and visible solid-waste removal do not establish that water is safe for bodily contact.
The first measurable river-restoration outcomes must therefore be:
- complete mapping of sewage and polluted storm-water outfalls;
- interception of every active discharge;
- functioning household and neighbourhood sewer connections;
- reliable pumping and treatment;
- compliant treatment-plant discharge;
- minimum ecological flow and tidal exchange;
- prevention of renewed dumping;
- and independently published water-quality results.
Only after these conditions are sustained should recreation and waterfront development become central performance measures.
The CRRT itself describes the urban Cooum as functioning largely as a sewer receiving wastewater and solid waste, while the April 2026 Adyar submission reported severely degraded water-quality conditions and a major sewage-interception requirement.
One agency must own the river outcome
Earlier restoration structures have divided responsibilities among CRRT, the Water Resources Department, Greater Chennai Corporation, Metro Water, municipal and rural-development departments and the Tamil Nadu Urban Habitat Development Board.
That division reflects real statutory responsibilities. It also creates an accountability problem.
One agency may complete a wall while another sewer connection remains unfinished. A treatment facility may be constructed while sewage continues entering through an unrecorded drain. A park may open while upstream pollution continues.
The new river programme needs a single accountable programme office with authority to:
- maintain the common river inventory;
- certify completion of each sewage-interception zone;
- coordinate land, sewerage and flood-management work;
- publish contractor and departmental performance;
- and prevent agencies from reporting individual works as complete while the river outcome remains unmet.
The appropriate unit of delivery is not the departmental contract.
It is the hydrological and pollution-control reach.
The Budget should publish a river project reconciliation
A public ledger should list every current and proposed Cooum and Adyar intervention.
| Required field | Why it matters |
|---|---|
| Project and package name | Prevents duplicate announcements |
| River reach and chainage | Establishes geographic coverage |
| Implementing agency | Fixes responsibility |
| Sanctioned and contracted cost | Distinguishes approval from procurement |
| Contractor or concessionaire | Identifies delivery responsibility |
| Current physical progress | Shows whether the project is active or stalled |
| Sewage outfalls covered | Connects expenditure to pollution control |
| Treatment capacity and actual flow | Prevents unused infrastructure being counted as success |
| Resettlement requirement | Makes social consequences visible |
| Water-quality baseline and target | Defines ecological success |
| New DPR relationship | Shows whether the Budget proposal supplements or supersedes the package |
Without this ledger, Chennai may commission another study without resolving why previously sanctioned programmes did not produce a visibly restored river.
Blue-green infrastructure needs a hydrological definition
The Budget also proposes blue-green infrastructure around Chennai’s water bodies, including interventions intended to improve flood resilience and create community spaces. It mentions raising retaining walls and erecting chain-link fencing to improve discharge capacity and protect environmental assets.
Walls and fencing can be necessary at specific locations. They are not, by themselves, blue-green infrastructure.
A credible blue-green programme would combine:
- restored lakes and wetlands;
- protected floodplains;
- permeable public spaces;
- bioswales and rain gardens;
- connected storm-water pathways;
- expanded water storage;
- urban tree systems;
- and safe overflow corridors.
Each project must begin with catchment and flood modelling. Raising a wall in one location can redirect risk elsewhere if the receiving channel or downstream water body lacks capacity.
Public-space development must also respect seasonal flooding. Parks designed within flood-sensitive areas should tolerate periodic inundation rather than obstruct it.
The Ring Main is a redistribution project
The ₹3,108-crore Ring Main Pipeline is the Budget’s most advanced water-system intervention. It is intended to connect Chennai’s major sources with distribution stations, allowing water to be redirected between zones and supporting more equitable and reliable supply. The Budget places completion by 2031.
Earlier tender reporting described three packages, approximately 98 km of ring main, 115 km of transmission mains, feeder connections, pumping systems, instrumentation and ten years of operations and maintenance. It targeted completion before February 2030 and identified Asian Development Bank-supported financing.
The difference between the 2030 and 2031 completion signals needs clarification.
It may reflect a revised programme date, procurement delay, broader commissioning scope or inclusion of associated distribution work. It should not be converted into a definitive public deadline until Metro Water publishes the current package schedule.
The Ring Main also needs to be described accurately.
It can move available water more flexibly between supply zones. It cannot independently solve drought, desalination outages, reservoir depletion or source contamination. Its value depends on the reliability of the lakes, reservoirs, desalination plants, pumping stations and local distribution networks connected to it.
Continuous supply requires local network reform
The Budget states that the Ring Main will support reliable, equitable and round-the-clock supply across Chennai.
The trunk network is necessary but insufficient.
Continuous household supply also requires:
- pressure-zone management;
- replacement of weak local pipes;
- reduction of leakage;
- legal household connections;
- prevention of unauthorised pumps;
- metering and flow monitoring;
- reservoir and distribution-station automation;
- and sufficient operating revenue.
A neighbourhood cannot receive 24×7 water merely because a high-capacity pipeline passes nearby.
Metro Water should therefore publish separate targets for:
- source availability;
- bulk transmission;
- distribution-station reliability;
- ward-level pressure;
- supply hours;
- non-revenue water;
- and household service continuity.
Streets and water systems must be coordinated
Chennai’s Budget package also proposes smart parking at 20 locations, road restructuring in the Ambattur and Guindy industrial estates, greener footpaths and a comprehensive street-redesign and mobility programme.
These works should be sequenced with the Ring Main, sewerage, storm-water and utility programmes.
No major road should be reconstructed before all planned underground work has been mapped and coordinated. Otherwise, public money will again be spent repairing newly completed surfaces after pipeline excavation.
An integrated urban mission becomes credible precisely at this interface: water, sewerage, streets, mobility and drainage must share one construction calendar.
The real Budget test
The allocation increase demonstrates that urban infrastructure has received substantial fiscal priority.
The critical test is not the size of the departmental number.
It is whether the government can show:
- which projects are new;
- which are continuations;
- which earlier projects are being restructured;
- which works are fully funded;
- what service or ecological outcome each rupee purchases;
- and who is accountable when the outcome is not achieved.
Chennai has repeatedly funded river cleaning, sewage interception, bank protection and beautification.
The new programme can be different only if it begins by publicly explaining the old one.
A restored river is not a completed DPR, a tender, a wall, a park or a treatment plant. It is a water system in which sewage no longer enters, ecological function returns, flood capacity is protected and residents can verify the improvement themselves.
