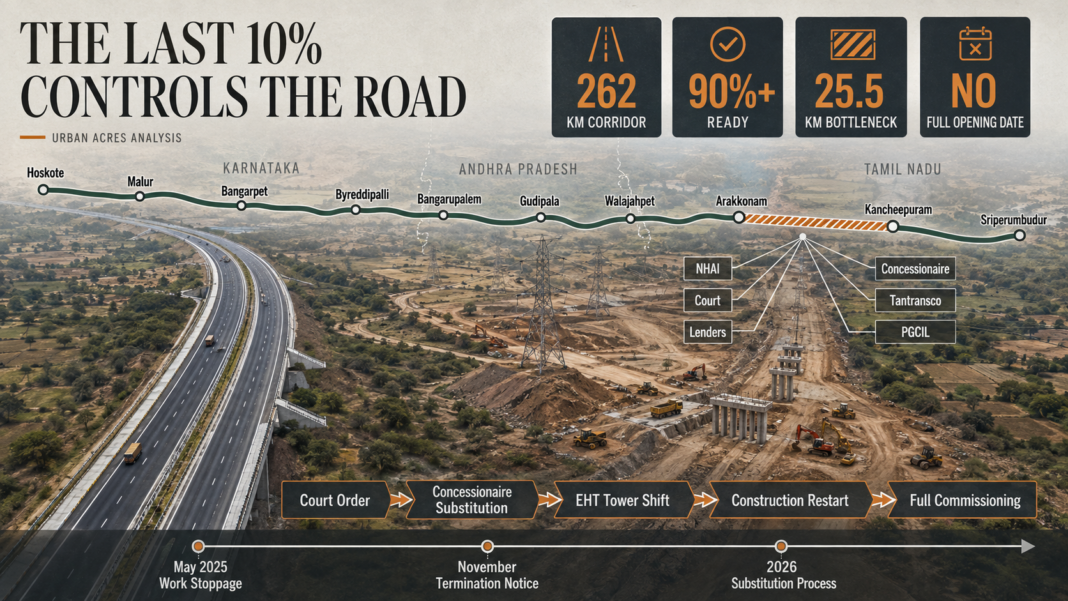

HomeUncategorizedChennai Bengaluru Expressway Delay Is Now a Contract Crisis

Chennai Bengaluru Expressway Delay Is Now a Contract Crisis

More than 90% of the Chennai–Bengaluru Expressway is reported ready, but a stalled 25.5-km package in Tamil Nadu is preventing the corridor from functioning as one continuous interstate transport system.

The Chennai Bengaluru Expressway delay is now concentrated between Arakkonam and Kancheepuram. Current parliamentary reporting places progress on this package at 53%, while most other sections across Karnataka, Andhra Pradesh and Tamil Nadu have either been completed or reached approximately 90% to 99%.

The package represents less than 10% of the approximately 262.4-km expressway. Yet the Union government has stated that the complete greenfield corridor can be commissioned only when every package, including Arakkonam–Kancheepuram, is finished.

This is the defining characteristic of network infrastructure.

A building can open floor by floor. A road network can sometimes open section by section. But an access-controlled intercity expressway delivers its full value only when the missing links no longer force traffic to exit, divert through the ordinary road system and re-enter later.

The stalled road is now a legal and financial asset

Construction on the Arakkonam–Kancheepuram package stopped in May 2025 after the concessionaire encountered financial constraints. NHAI subsequently issued an intention-to-terminate notice on November 10, 2025. Senior lenders then proposed using their contractual right to substitute the concessionaire.

The concessionaire challenged the termination process in the Madras High Court. The latest report says the court directed NHAI to maintain the status quo and has reserved its order. NHAI officials estimate that the package could be completed within six months once legal clearance permits work to resume under an acceptable delivery arrangement.

That six-month estimate is conditional.

It does not begin from the date of the newspaper report. It begins only after the legal process allows substitution or another enforceable restart, the replacement entity mobilises, the remaining design and construction risks are reassessed, and access to all work fronts is available.

The project should therefore not be assigned a new full-opening date by simply adding six months to August 2026.

Why NHAI cannot merely issue another tender

The package is being delivered under Hybrid Annuity Mode.

The concessionaire—DP Jain Bangalore–Chennai Expressways Pvt. Ltd.—is a special-purpose project company. Its original financing combined sponsor funds, bank debt and NHAI construction payments. The lender consortium includes Bank of Maharashtra, UCO Bank and Central Bank of India.

Under the original structure, NHAI’s construction grant represented 40% of the project cost, with the balance funded through debt and equity. The private project company would then operate the asset during a 15-year concession and receive annuity payments after commercial operation began.

The road package is therefore not simply an incomplete civil contract.

It contains:

  • an existing concession agreement;
  • government grant already linked to achieved milestones;
  • lender exposure;
  • incomplete physical assets;
  • outstanding obligations;
  • sponsor equity;
  • operation and maintenance rights;
  • and disputed termination action.

Lender substitution is designed to preserve project continuity by replacing the defaulting project sponsor or concessionaire without discarding the entire contractual and financing structure.

That mechanism may be faster than termination and fresh procurement—but only when the lenders, NHAI, court and incoming concessionaire can agree on the unfinished work, outstanding debt, revised construction cost and future annuity rights.

The deadline has already moved repeatedly

The package was awarded in September 2021. Its concession agreement was signed in February 2022, and the appointed date was declared in August 2022. The original construction period was 730 days.

The scheduled completion date moved through four milestones:

  • March 31, 2024;
  • March 31, 2025;
  • October 31, 2025;
  • July 31, 2026.

None resulted in completion.

This sequence changes how the next deadline should be assessed.

A new date should not be announced until the responsible concessionaire is contractually established, the remaining quantities have been independently verified, utility shutdowns are scheduled and a funded construction programme has been accepted.

Otherwise, another date will function as a political aspiration rather than a project-control milestone.

Progress data is not internally consistent

The current parliamentary reporting cited by TOI places the Arakkonam–Kancheepuram package at 53%. A lender bid-process document dated June 2026 records physical progress of 69.66%.

These numbers may use different dates or methods.

One may measure completed road length. Another may weight earthwork, structures, pavement, utilities and financial milestones differently. The latest report also says 14.47 km of the 25.5-km package remains pending, implying about 11.03 km completed by length.

The public cannot determine the true position without a component-level breakdown.

NHAI should publish:

  • completed and pending road length;
  • earthwork;
  • structures;
  • pavement layers;
  • interchanges and underpasses;
  • electrical relocation;
  • drainage;
  • safety barriers;
  • toll and ITS infrastructure;
  • and testing or certification.

One percentage cannot meaningfully describe a package that has remained physically stalled while contractual and financing work continues.

Utility clearances remain a second critical path

The principal current reason for stoppage is the concessionaire’s financial failure. The latest parliamentary update also identifies historical delays involving land acquisition, electrical utility shifting, railway power blocks and relocation of railway switching posts.

Most of these issues are reported resolved. EHT tower relocation, however, still requires line closure involving Power Grid Corporation and Tantransco. The matter has been raised with the Tamil Nadu government.

This is important because contractor substitution and utility clearance are separate critical paths.

A replacement concessionaire cannot complete a road section where high-voltage towers remain in the construction envelope. Conversely, shifting the towers will not restart work while the legal authority to replace the concessionaire remains unresolved.

The completion programme must therefore show both dependencies:

Court and lender substitution → contractor mobilisation

and

Power shutdown approval → EHT tower relocation → construction access

A date based on only one chain will be unreliable.

Other packages are close—but not identical

The latest Chennai report says the corridor is more than 90% ready. It records:

  • completion and operation up to Byreddipalli from the Bengaluru side;
  • 93% progress on Byreddipalli–Bangarupalem;
  • completion of Bangarupalem–Gudipala;
  • approximately 99% on Gudipala–Walajahpet;
  • approximately 98% on Walajahpet–Arakkonam;
  • 53% on Arakkonam–Kancheepuram;
  • and approximately 90% on Kancheepuram–Sriperumbudur.

Current reports differ on how much is already open—approximately 96.7 km in one account and 105 km in another.

That discrepancy may arise from different chainage references, access points or the treatment of the interstate section. NHAI should publish an operational map showing:

  • exact chainages open to traffic;
  • entry and exit points;
  • toll points;
  • services and emergency facilities;
  • sections still under traffic control;
  • and prohibited incomplete connections.

Without that map, “open” can mean physically paved, provisionally accessible or formally commissioned—three different conditions.

The corridor’s cost also needs reconciliation

The project was announced in 2022 at over ₹14,870 crore. A 2025 Lok Sabha package table totalled ₹15,188 crore, while a later central-government infrastructure summary used a total capital-cost figure of ₹17,356 crore.

These figures may reflect different definitions, dates and included costs. For example, one may represent awarded package cost, another total capital expenditure including land, or an updated programme estimate.

They should not automatically be described as a cost overrun.

They do reveal a disclosure weakness. NHAI should issue one reconciled statement distinguishing:

  • civil construction;
  • land acquisition;
  • utility relocation;
  • supervision;
  • financing;
  • claims and settlements;
  • revised package costs;
  • and remaining expenditure.

The unresolved package itself appears under several cost bases. A Lok Sabha annex lists total project cost at ₹1,155.49 crore, while the lender document records an original project cost of ₹1,057.01 crore and an NHAI estimated project cost of ₹855.86 crore.

The correct reporting practice is therefore to identify each figure’s source and definition rather than select the largest or newest number without context.

Partial opening provides only partial economic value

Completed portions can still generate benefits. Motorists in Karnataka and Andhra Pradesh can use operational sections, and staged opening allows NHAI to place completed assets into service rather than leaving them idle.

But the original economic proposition is end-to-end connectivity.

The expressway was presented as a route that could reduce travel time between the two metropolitan regions by two to three hours.

That promise depends on:

  • an uninterrupted controlled-access road;
  • predictable toll and access arrangements;
  • high operating speeds;
  • safe interchanges;
  • and efficient connections at Hoskote and Sriperumbudur.

A diversion through ordinary roads at the missing package removes part of the reliability advantage. Freight operators value predictability as much as top speed. A corridor that is fast for 200 km but uncertain at one unfinished section cannot yet function as the promised industrial logistics spine.

Completion will not solve the metropolitan last mile

Even after the expressway opens, it will connect the outskirts of the two metropolitan regions rather than their city centres.

On the Chennai side, the corridor reaches the Sriperumbudur industrial belt. Travellers and freight must continue through metropolitan roads towards Chennai, its industrial estates, logistics facilities, airports or ports.

On the Bengaluru side, access begins near Hoskote.

The full performance test must therefore measure:

  • Hoskote-to-Sriperumbudur travel;
  • door-to-door Bengaluru–Chennai travel;
  • peak congestion at terminal interchanges;
  • freight time to Chennai-region ports and factories;
  • crashes and breakdowns;
  • and traffic diversion from existing NH-48 and the Hosur route.

The expressway can dramatically improve the intercity segment while leaving congestion at both urban edges intact.

What should happen next

The Arakkonam–Kancheepuram package needs a publicly visible recovery sequence.

Step 1: Resolve legal authority

Publish the court’s operative order once delivered and state whether NHAI may terminate, permit lender substitution or must continue with the existing concessionaire.

Step 2: Complete substitution

Identify the nominated concessionaire, financing plan, revised obligations and effective transfer date.

Step 3: Audit unfinished work

Conduct an independent condition and quantity survey of all completed earthwork, structures and pavement before the new entity accepts responsibility.

Step 4: Clear utilities

Publish dated power blocks for EHT tower relocation and confirmation from Tantransco, PGCIL and affected railway authorities.

Step 5: Set a restart-based deadline

The six-month completion estimate should begin from full mobilisation and work-front availability—not from a press statement.

Step 6: Publish monthly package data

Report construction quantities, workforce, equipment, utility completion, expenditure and risks.

Step 7: Commission the corridor as a system

Complete safety audit, toll systems, incident management, emergency response, signage and user facilities across every package before declaring full opening.

The wider Tamil Nadu warning

The Centre has also reported that 18 National Highway projects in Tamil Nadu are delayed by combinations of land acquisition, material procurement and contractor performance.

The expressway package is therefore both a specific contract failure and a wider delivery warning.

Large infrastructure projects are commonly delayed not by one engineering impossibility but by accumulated interfaces:

  • land;
  • power utilities;
  • railways;
  • construction materials;
  • contractor finance;
  • lenders;
  • courts;
  • and state–central coordination.

Project management must treat each interface as part of the infrastructure, not as an external administrative issue.

The evidence supports the conclusion that the physical expressway is close to completion.

What the evidence does not support is a definite end-to-end opening date.

A court order is pending. Concessionaire substitution is incomplete. EHT tower line closure remains unresolved. Public progress and cost figures are not fully reconciled.

The final 25.5 km is not merely the last road section.

It is the section where India’s highway-contract, banking, judicial and utility-governance systems must prove that they can recover a strategically important project after private delivery failure.
