The Vidyavihar Road Over Bridge (ROB), a key infrastructure development for eastern Mumbai, is now slated to be operational by April 2026. This crucial bridge, which connects Lal Bahadur Shastri (LBS) Marg and Ramkrishna Chemburkar Marg, has been in the works since its proposal in the 1991 Development Plan.
However, progress on the project has been plagued by years of inactivity, delays, and logistical challenges. Formal construction only began in 2018, following years of bureaucratic hurdles and necessary realignment of plans. Despite the promise of relief for commuters, the long-standing project still faces several challenges before it can offer its intended benefits. The impact of the Vidyavihar ROB on local traffic congestion is expected to be substantial. Commuters from Mumbai’s eastern suburbs, particularly those travelling through Ghatkopar or Kurla, have long had to deal with inconvenient detours due to the absence of a direct connection over the railway tracks. The closure of this critical gap forces vehicles onto already congested alternate routes, which has often led to a bottleneck during peak hours. Residents who rely on these routes for daily travel have been vocal about the strain the lack of infrastructure has caused, particularly when the closure has led to significant delays during rush hours. With the completion of the bridge, these bottlenecks are expected to ease, enabling smoother travel and reduced commute times for thousands of people.
However, the journey towards completing this bridge has not been smooth. The Brihanmumbai Municipal Corporation (BMC), which is overseeing the project, has encountered numerous hurdles in its execution. One of the primary challenges involved the removal of around 80 unauthorised constructions in the area, a task that required considerable time and effort. In addition, the transplantation and cutting of trees, the shifting of railway ticket counters, and the realignment of stormwater drainage systems further delayed work. Furthermore, the project’s steel requirements were greater than initially anticipated, further pushing back timelines. These issues have contributed to the prolonged construction period, much to the frustration of local residents who have had to endure extended periods of inconvenience.

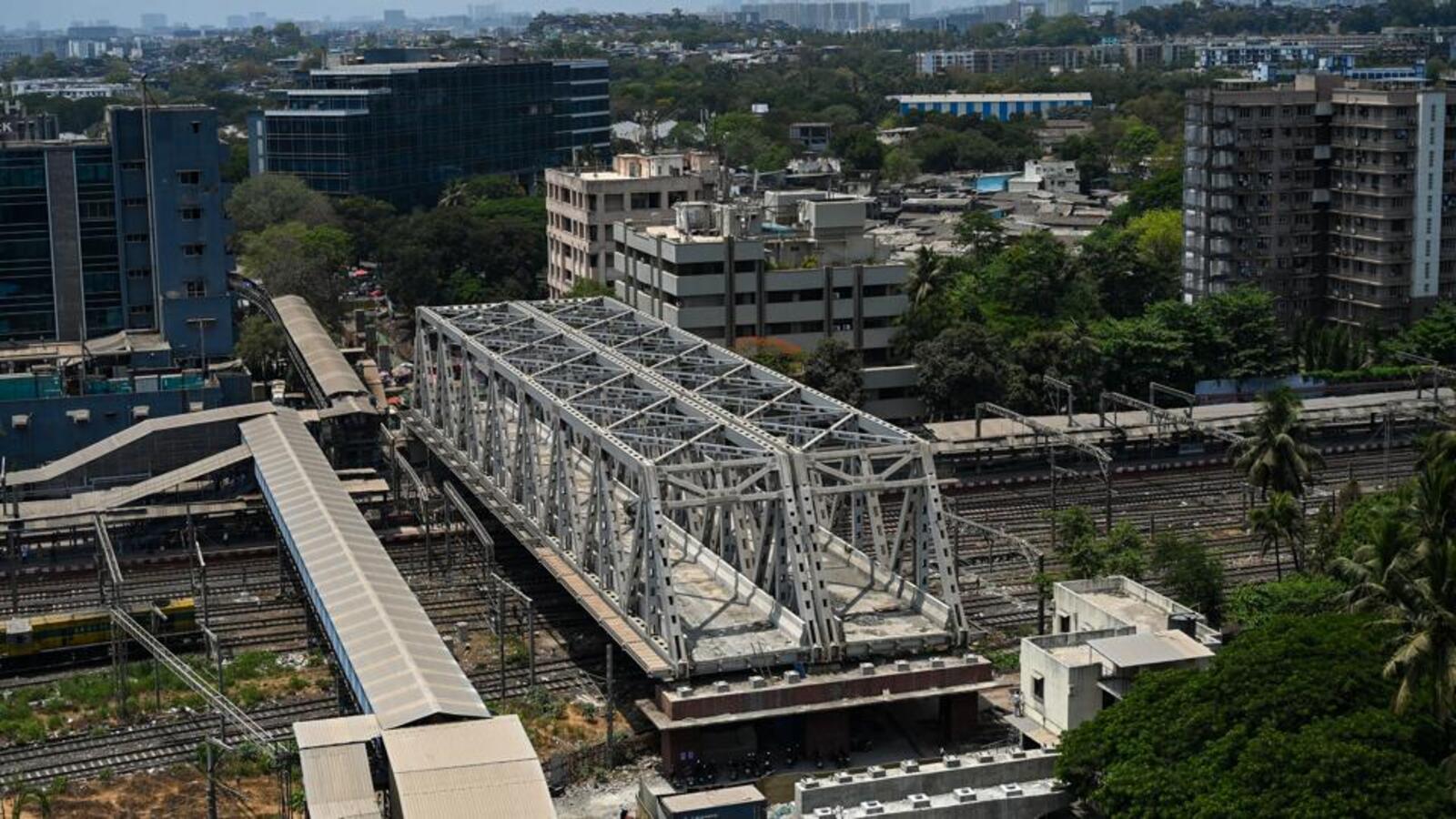

Despite these setbacks, significant progress has been made. The bridge spans an impressive 650 metres and is among the longest in the city. The first girder of the bridge was installed in May 2023, followed by the second in November 2023. Only after these critical components were in place did work begin on the approach roads in February 2024. The construction of the bridge’s girders, each weighing around 1,100 metric tonnes, required intricate logistical planning and coordination. While the bridge’s completion is now within reach, some local residents continue to raise concerns about potential congestion in the surrounding areas. As the widening of approach roads continues, many fear that the bridge will only shift traffic to nearby junctions, creating new congestion hotspots. The true test will be whether the infrastructure improvements can handle the growing volume of vehicles without exacerbating existing traffic issues.
The Vidyavihar ROB is part of a broader effort to improve Mumbai’s transportation network, especially in the eastern suburbs, where traffic congestion has long been a pressing issue. While the completion of this bridge will undoubtedly ease the flow of traffic on LBS Marg and Ramkrishna Chemburkar Marg, the city’s infrastructure planners will need to remain vigilant. Other key bridge projects in the area, including those at Bhandup, Vikhroli, and Ghatkopar, are still under construction, but without clear timelines for their completion, the relief promised by the Vidyavihar ROB could be short-lived. These ongoing projects are critical to ensuring a comprehensive solution to the traffic woes faced by Mumbai’s eastern suburbs. The completion of the Vidyavihar ROB may mark an important milestone, but much work remains to ensure that the city’s infrastructure can keep pace with its growing population and traffic demands.
